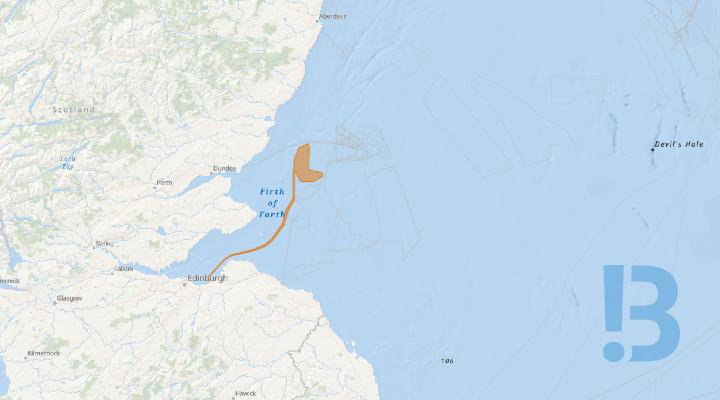

Export Cable Joint Trenching - Inch Cape export cable corridor

All mariners and stakeholders are advised that export cable joint trenching activities will commence within the Inch Cape export cable corridor.

Export cable joint burial at KP28 & 56 is postponed until further notice.On behalf of Inch Cape Offshore Ltd, Enshore will commence burial of export cable sections 1,2 & 3 from Cockenzie, East Lothian to the Inch Cape offshore substation.The trenching vessel, CMOS Installer shall utilise a jetting burial tool and a remotely operated vehicle (ROV) to bury the cable. CMOS Installer is expected to arrive at the export cable corridor on or around the 12th of December to commence trials followed by burial operations which are expected to continue until February 2026.

See detailed map on our bulletin website
Show More

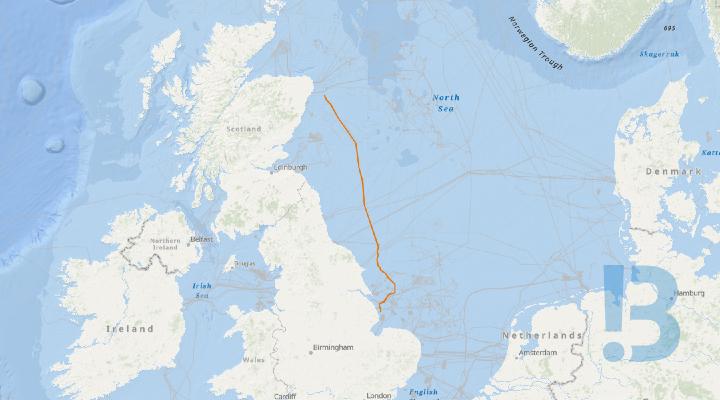

Demarcation / Met-Ocean Buoys - Sofia Offshore Wind Farm

All Mariners are advised that on or around 12th December 2025 (weather permitting), the Multicat "Green Isle" or Support Vessels "Isle of Jura", "MJM Enterprise", "Kingdom of Fife" "Silex" all have potential to commence the Autumn service campaign on the infield Demarcation & Met-Ocean Buoys of the SOWF array site.

Note: There is a possibility (to utilise small weather windows) that an additional 5 (five) x Metocean Buoys will be installed within the Sofia Offshore Wind Farm Array. The coordinates for the buoys are below.

Vessels shall be monitoring channel VHF 16 and shall be displaying the relevant day shapes / night lights when restricted in its ability to manoeuvre.

Mariners are requested to refrain from entering and transiting through the construction area as demarcated by these demarcation buoys.

The table below provides a summary of each Cardinal and Special Mark Buoy deployed at the SOWF array, including target coordinates in WGS84 Degrees Decimal Minutes and a description of top mark and lantern characteristics. The Demarcation Buoys will be deployed for a period of approximately three years.

Buoy ID Latitude Longitude Lantern Characteristics Lantern  Colour
North Cardinal N1 55° 08.133’ N 002° 09.518' E

VQ 0.5s

White
North Cardinal N2 55° 08.436’ N 002° 13.418’ E

Q 1s

White
East Cardinal E1 55° 06.480’ N 002° 16.929’ E

Q(3) 10s

White
East Cardinal E2 55° 02.571’ N 002° 23.925' E

VQ(3) 5s

White
East Cardinal E3 54° 59.043’ N 002° 30.269’ E

Q(3) 10s

White
East Cardinal E4 54° 55.085’ N 002° 26.631’ E

VQ(3) 5s

White
East Cardinal E5 54° 51.523’ N 002° 20.709' E

Q(3) 10s

White
South Cardinal S1 54° 49.725’ N 002° 16.726' E

Q(6) + LFL 15s

White
West Cardinal W1 54° 51.829’ N 002° 12.194' E

Q(9) 15s

White
West Cardinal W2 54° 56.229’ N 002° 03.867' E

VQ(9) 10s

White
West Cardinal W3 55° 00.623’ N 001° 56.196' E

Q(9) 15s

White
West Cardinal W4 55° 04.648’ N 002° 02.498' E

VQ(9) 10s

White
Special Mark SP1 55° 02.741’ N 001° 59.265' E

FI Y 5s

Yellow
Special Mark SP2 55° 06.569’ N 002° 05.756' E

FI Y 5s

Yellow
Special Mark SP3 55° 04.525’ N 002° 20.428' E

FI Y 5s

Yellow
Special Mark SP4 55° 00.617’ N 002° 27.418' E

FI Y 5s

Yellow
Special Mark SP5 54° 56.871’ N 002° 29.602' E

FI Y 5s

Yellow
Special Mark SP6 54° 53.324’ N 002° 23.621' E

FI Y 5s

Yellow
Special Mark SP7 54° 54.030’ N 002° 08.026' E

FI Y 5s

Yellow
Special Mark SP8 54° 58.427’ N 001° 59.703' E

FI Y 5s

Yellow

The table below provides a summary of the Met-ocean Buoys deployed at the SOWF Array.

Site Location Buoy Position Latitude Longitude Deployment Date Recovery Date
SOWF Array North 55 05.392N 002 12.993E June 2023 June 2026
SOWF Array South 54 54.987N 002 15.585E June 2023 June 2026
SOWF Array East 54 58.160N 002 22.521E March 2024 June 2026
SOWF Array West 55 01.528N 002 04.052E March 2024 June 2026
SOWF OCP 55 00.439N 002 14.798E March 2024 June 2026

The table below provides a summary of additional Met-Ocean Buoys to be deployed at the SOWF Array.

Site Location Buoy Position Latitude (DDM) Longitude (DDM)
SOWF Array North 55 05.5423N 002 12.8775E
SOWF Array South 54 54.8995N 002 15.355E
SOWF Array East 54 58.3147N 002 22.6093E
SOWF Array West 55 01.4554N 002 03.8113E
SOWF OCP 55 00.2782N 002 14.8262E

See detailed map on our bulletin website
Show More

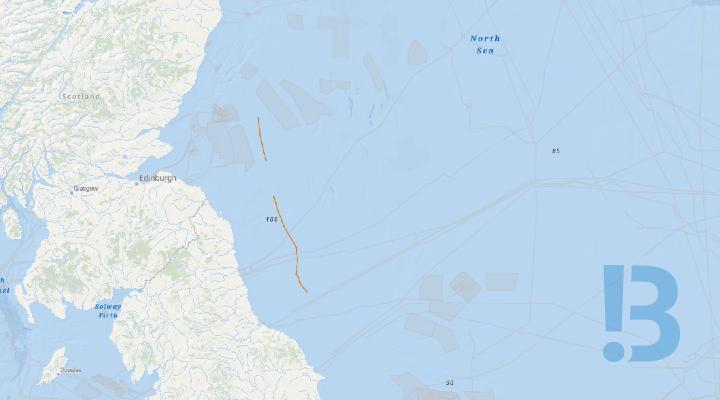

Demarcation Buoyage Unlit - Inch Cape

The Inch Cape site demarcation buoyage noted below has been repaired and operating normally.Maintenance including the replacement of marine lanterns on the remaining seven demarcation buoys will now take place. • North Cardinal demarcation buoy lantern replaced • South Cardinal 1 demarcation buoy replaced • South Cardinal 2 demarcation buoy replaced • Special Mark 6 demarcation buoy replaced

The Inch Cape site demarcation buoyage noted below has been repaired and is operating normally.

·       North Cardinal demarcation buoy lantern replaced

·       South Cardinal 1 demarcation buoy replaced

·       South Cardinal 2 demarcation buoy replaced

·       Special Mark 6 demarcation buoy replaced

On behalf of Inch Cape, OEG Ltd. will carry out maintenance on the remaining 7 demarcation buoys which will include the replacement of the marine lanterns on each buoy.

Locations of the 7 buoys including coordinates are shown below in section 3.

The multi cat vessel MV Cameron is expected to arrive at Inch Cape on the week commencing 8th Dec to commence the maintenance, operations are expected to be complete in 2 days dpending on weather.

See detailed map on our bulletin website
Show More

Q&E North potential cable exposures

Please be aware that EXA Infrastructure hereby provides notification of potential exposures on the Q&E North Cable at the following locations: Location 1 - 51° 22.9683' N   1° 42.0589' E  - 51° 22.7174' N   1° 43.3431’ E Location 2 - 51° 22.4637' N 1° 48.3624’ E - 51° 22.4677' N 1° 48.7115’ E All seabed users are politely requested to avoid these areas due to the risk of snagging any equipment engaging with the seabed.

Show More

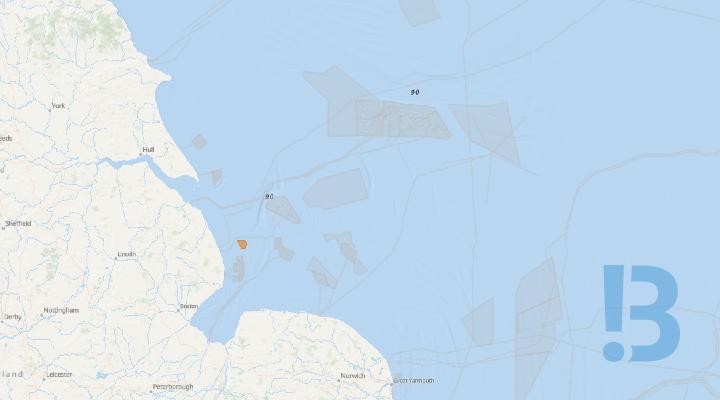

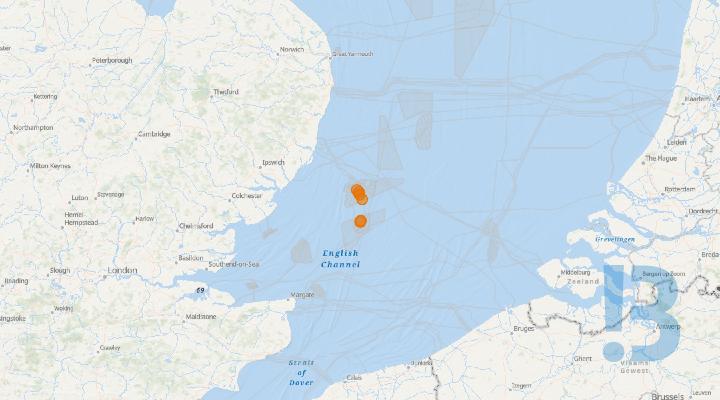

Cable exposures - IFA2000 Interconnector

A cable route maintenance survey has detected a section of cable with intermittent exposures and potential free spans in the UK sector of the IFA 2000 Interconnector. These exposures are found across all four cables west of 001° 17.2’E . Fishing vessels are advised to keep clear of this area.

The exposures are present intermittently across all four cable routes in the area bounded by:

51° 5.23’N 001° 17.20’E 51° 3.33’N 001° 17.20’E 51° 5.00’N 001° 11.67’E 51° 4.88’N 001° 11.67’E

Application for licence to remediate exposures has been submitted. Fishermen are requested to stay well clear.

See detailed map on our bulletin website
Show More

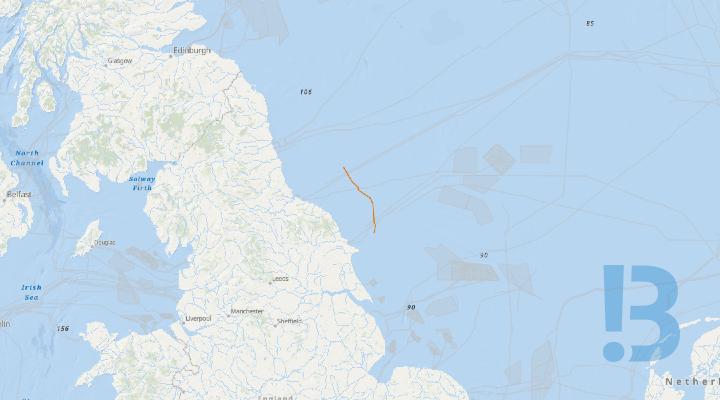

Navigation Warning - Unlit Buoyage (E3) - Sofia Offshore Wind Farm

Mariners are advised of an unlit East Cardinal Buoy at the Sofia OWF.

A remedey plan is currently being worked on to support reinstatement of the unlit buoy.

Buoy ID Lat (DDM) Long (DDM) Light and Mark Specifications
East Cardinal E3 54 59.04N 002 30.27E
  • Pillar shaped with and east cardinal shaped top
  • Exhibiting a Q (3) 10s light character

See detailed map on our bulletin website
Show More

Offshore Converter Platform Commissioning Works - Sofia Offshore Windfarm

Mariners are advised that the Valaris 248 is positioned alongside the Offshore Converter Platform supporting the ongoing commissioning programme.

A scheduled service from an assigned pool of Platform Supply Vessels providing supplies to the Offshore Converter Platform & JUV until further notice.  Those nominated vessels are:

  • Bos Pool;
  • Bos Base;
  • Dina Merkur;
  • Dina Supporter;
  • Dina Supplier;
  • Dina Scout;
  • Highland Knight - Circa December 2025 (TBC)

An eight legged jacket with 8 driven pin piles has been installed as a foundation for the OCP followed by the OCP itself.

The Sofia Offshore Wind Farm Boundary Co-ordinates where the works will take place are provided below.  All non-project vessels are requested to remain outside this area.

Mariners are requested to remain where possible 500m from vessels. During these works, SOVs will have restricted manoeuvrability and shall also be exhibiting the correct day shapes/ lights and flag for vessels engaged in diving operations and restricted in ability to manoeuvre.

Emergency Response & Rescue Vessel

The EERV Putford Protector is supporting the commissioning phase of the Offshore Converter Platform, providing close standby cover as required during overside works.

Service Operation Vessels

The Service Operations Vessel (SOV) “Rem Power” & Daughter craft “Rem Transporter” continues to support the SOWF project throughout the construction of the offshore windfarm.

The 'SOVs' ACTA Centaurus and Austri Enabler continues operations within the Sofia Array.

SOVs shall be transiting to / from the Sofia Array and the port of Blyth / Sunderland throughout this period.

Crew Transfer Vessel

The Crew Transfer Vessel (CTV) MHO Balder continue operations at the Sofia OWF.

All Mariners are advised to always give a wide berth of approx. 500m metres from the above vessels. The vessels shall be exhibiting the correct day signals / night lights for the operations as defined by COLREGS and can be contacted on VHF 16 for further information as required reference proximity / nearby operations etc.

See detailed map on our bulletin website
Show More

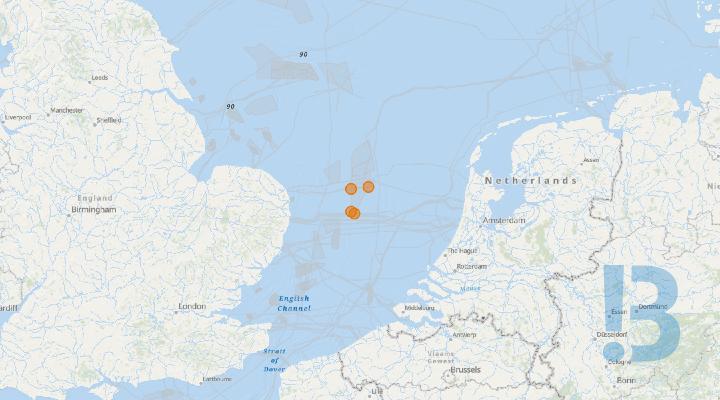

Wind Turbine Generator Installation & Commissioning Works - Sofia Offshore Wind Farm

All Mariners are advised that the SGRE Vessel “Wind Peak” continues Wind Turbine (WTG) Generator installation at the Sofia Array. The vessel will also be supported by ongoing commissioning activities carried out with the following SGRE Vessels: “IWS SeaWalker”, “FOB Swath 9” & “FOB Swath 10”.

The following table highlights WTG installation progress and next 7 day forecast.

Total WTGs Installed

(100 in Total)

WTGs Installed (Since Previous Update) WTGs Location Forecast (Next 7 Days)
64 N/A A09, J09 – Trip 11.

Vessels operational during these works are as follows:

Vessel Name Vessel Type Length (M) Gross Tonnage IMO Call Sign MMSI Number
Wind Peak WTG Installation Vessel 150 34100 9957828 OZVU2 219032994
IWS Seawalker Service Operation Vessel 90 6712 9968580 LAVP8 257784000
FOB Swath 9 Crew Transfer Vessel 33 372 9920576 OYKP2 219027989
FOB Swath 10 Crew Transfer Vessel 32 372 9920588 OYMX2

219027988

The exact finish date will be dependent on the prevailing weather conditions and work progress. Mariners are requested to remain where possible 500m from Construction vessels when exhibiting the day shapes / night lights for vessels restricted in their manoeuvrability.

Service Operation Vessels

The Service Operations Vessels (SOV) “Rem Power” & Daughter craft “Rem Transporter” continues to support to the SOWF project throughout the construction of the offshore windfarm.

The SOV 'ACTA Centaurus' and 'Austri Enable continues operations within the Sofia Array.

SOVs shall be transiting to / from the Sofia Array and the port of Blyth / Sunderland throughout this period.

Crew Transfer Vessel

The Crew Transfer Vessel (CTV) MHO Balder continues operations at the Sofia OWF.

All vessels can be contacted on VHF 16 throughout as required. All vessels shall be operating to / from the Port of Hull and will be operational 24 hours / day.

See detailed map on our bulletin website
Show More

Offshore Construction - Dogger Bank C Offshore Wind Farm

Offshore Construction of the Dogger Bank C Offshore Wind Farm commenced on the 5th of October 2024. The development of the windfarm is made up of several elements - current ongoing elements are described below in the 'full notice' and in the attached file. This notice will be updated weekly, giving information on the progress and resources involved in the offshore project.

Inter Array Cable Installation

The Cable Lay Vessel (CLV) Viking Neptun has completed the first round of inter array cable installation works. The Cable Burial Vessel Assister will conduct trenching operations on surface laid Inter Array Cables (IAC). The Service Operations Vessel, Norside Cetus will continue with IAC termination and testing works.

During operations, the Assister and Norside Cetus will be restricted in their ability to manoeuvre as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessels will also transmit an Automatic Identification System (AIS) message.

See detailed map on our bulletin website
Show More

Offshore Construction - Dogger Bank B Offshore Wind Farm

Offshore Construction of the Dogger Bank B Offshore Wind Farm commenced on the 21st of April 2023 with the installation of the OSP jacket foundation. This notice will be updated weekly, giving information on the progress and resources involved in the offshore project. The intention is to give an overview of activities and vessels involved. Should anyone have questions regarding the operations, we kindly ask you to put them forward well in advance.

Construction Support Activities

The Offshore Construction Support Vessels Grampian Tees, Grampian Tweed and Grampian Eagle will continue with ongoing construction support activities within Dogger Bank B construction site.

The Fall Pipe Vessel (FPV) Rollingstone will resume subsea rock installation at various locations within the Dogger Bank B construction area.

See detailed map on our bulletin website
Show More

Offshore Construction - Dogger Bank A Offshore Wind Farm

Offshore Construction of the Dogger Bank A Offshore Wind Farm commenced on the 18th of March 2022. The development of the windfarm is made up of several elements - current ongoing elements  are described below in the 'full notice' and in the attached file. This notice will be updated weekly, giving information on the progress and resources involved in the offshore project.

The development of the windfarm is made up of several elements - current ongoing elements include:

Construction Support Activities

The Offshore Construction Support Vessels Boreas Enabler,  IWS Skywalker, IWS Starwalker, and Grampian Tyne will carry out construction support activities within Dogger Bank A construction site.

Wind Turbine Generator (WTG) Installation

The Jack-up WTG Installation Vessel, Voltaire, will install wind turbine generators (WTG) within the Dogger Bank A construction area. the Voltaire has completed scheduled maintenance and has returned to WTG Installation operations.

The works commenced on the 18th of July 2023, continuing until approximately Q4 2025.  The works will be continuous, 24 hours a day.  A running list of the completed WTG installations and the next locations to be installed is presented in the Installation progress table in the WNoO.

See detailed map on our bulletin website
Show More

Hydrographic Seabed survey - Greater Gabbard Wind Farm

Seabed survey on 6 locations within the Greater Gabbard wind farm

Seabed survey in preperation for the Jack up campaign in January/February

6 assets (IGH05, X 18, IGF01, IGL01, GAD03, GAD04)

See detailed map on our bulletin website
Show More

Esvagt Server - JB 120 Anchor Handling

Mariners are advised that circa the 07/12/2025, ESVAGT SERVER is expected to arrive within the East Anglia THREE Windfarm area set out in section 2 of this document, with the intention of assisting with anchor handling operations with the ‘JB 120’ During the Installation period, vessels are requested to maintain a minimum 2000m safety distance from the JB 120’ and supporting tugs.

The jack-up vessel ‘JB 120’ will be positioned alongside the East Anglia THREE Offshore Converter Station (OFCS) within the East Anglia THREE Offshore Windfarm area. The activity will consist of the following three phases:

1.  Jacking-Up Procedure: The JB 120 will be temporarily soft jacked on a safe stand-off position, whilst four temporary anchors and mooring lines are deployed by the anchor handling vessel. The deployed mooring lines will be used to move the JB 120 safely towards its final position, where it will be fully jacked.

2.  Operational Phase: Once jacked up, the JB 120 will remain stationary for an estimated six months.

During operations, the ‘JB 120’, Anchor handling tug, Assistant tug and Lead tug will be restricted in their manoeuvrability as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. All vessels will transmit an Automatic Identification System (AIS) message.

A 500m statutory safety zone will then be maintained around the ‘JB 120’ at all times.

See detailed map on our bulletin website
Show More

Debri following Collision - Unmanned Survey Vessel

Unmanned survey vessel debri following collision. Planning is underway to recover this, likely to be Spring 2026

Show More

Metocean Seabed Frame Deployments in NW Skye & South Uist

Partrac Ltd., on behalf of Jan De Nul and SSEN, is deploying a metocean seabed frame mooring at three landfall sites for an interconnector cable project between NW Skye and South Uist. The seabed frame sites are located in Holmar Bay (Uist), Ardmore Bay (Skye) and Meanish Pier in Loch Pooltiel (Skye), and each frame will be deployed for 30 days. Partrac is planning to carry out the frame deployments from 10/12/2025 over two days, weather permitting, using the vessel C-Force.

Partrac Ltd., on behalf of Jan De Nul and Southern Electricity Networks (SSEN), is deploying a metocean seabed frame mooring at three landfall sites for an interconnector cable project between NW Skye and South Uist. The seabed frame sites are located in Holmar Bay (Uist), Ardmore Bay (Skye) and Meanish Pier in Loch Pooltiel (Skye), and each frame will be deployed for 30 days. Partrac is planning to carry out the frame deployments from 10/12/2025 over two days, weather permitting, using the vessel C-Force.  During deploymentactivities, the vessel will be restricted in their ability to manoeuvre and will display the appropriate lights and shapes prescribed by the International Regulations for Preventing Collisions at Sea. Other vessels are requested to provide a minimum clearance of 50m from the installation vessel during operations, and post-installation, and to pass at a safe speed.

See detailed map on our bulletin website
Show More

Wind Server Jack-up vessel - Sheringham Shoal and Dudgeon Offshore Wind Farms

The Wind Server jack-up vessel is expected to arrive from 12th December 2025 and work for minimum 28 days. The jack-up will transit to site and then work at, and transit between WTGs C01, E03, F04, F08, H02, K03, K07.

More details in the attached notice to mariners.

See detailed map on our bulletin website
Show More

Marine Aggregate - Humber Seabed Sampling

Mariners are advised that from 8 September 2025 the survey vessel 'Seren Las' will be undertaking a seabed sediment survey within the vicinity of the aggregate dredging site (Area 1805) located off the coast of Lincolnshire in the Humber Dredging Region, for approximately 2 weeks, weather and work progress depending.

The survey will acquire seabed sediment samples using a Hamon grab and will be completed by personnel from Ocean Ecology from the vessel Seren Las.

See detailed map on our bulletin website
Show More

Jack up Barge (JB 120) - East Anglia THREE Offshore Converter Station (OFCS)

Mariners are advised that circa the 04/11/2025, the Jack-up Barge (JUB) ‘JB 120’ will transit to, and jack up alongside the East Anglia THREE Offshore Converter Station (OFCS) within the East Anglia THREE Windfarm area set out in section 2 of this document, with the intention of remaining on station for approximately 6 months.

The jack-up vessel ‘JB 120’ will be positioned alongside the East Anglia THREE Offshore Converter Station (OFCS) within the East Anglia THREE Offshore Windfarm area. The activity will consist of the following three phases:

1.   Rig move: The JB120 will be towed and maneuvered to its designated location by use of tug vessel.

2.  Jacking-Up Procedure: The JB120 will be temporarily soft jacked on a safe stand-off position, whilst four temporary anchors and mooring lines are deployed by the anchor handling vessel. The deployed mooring lines will be used to move the JB120 safely towards its final position, where it will be fully jacked.

3. Operational Phase: Once jacked up, the JB120 will remain stationary for an estimated six months.

During operations, the ‘JB 120’, Anchor handling tug, Assistant tug and Lead tug will be restricted in their manoeuvrability as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. All vessels will transmit an Automatic Identification System (AIS) message.

See detailed map on our bulletin website
Show More

Moray East Wind Farm - Geophysical surveys around WTG J08

Please be advised that Moray Offshore Windfarm (East) Limited (Moray East) are planning to undertake a geophysical survey around WTG J08. Survey operations will be carried out by the Unmanned Surface Vessel: X-17 (vessel specs in Table 2), which is expected to arrive at site on 06/12/2025, subject to weather. The geophysical survey scope is a Multibeam Echosounder (MBES) survey, completing a 270m x 270m box around WTG J08 (location below in Table 1).

1.  Geophysical surveys around WTG J08 at Moray East Wind Farm – REV 1 change of vessel

Please be advised that Moray Offshore Windfarm (East) Limited (Moray East) are planning to undertake a geophysical survey around WTG J08. Survey operations will be carried out by the Unmanned Surface Vessel: X-17 (vessel specs in Table 2), which is expected to arrive at site on 06/12/2025, subject to weather.

The geophysical survey scope is a Multibeam Echosounder (MBES) survey, completing a 270m x 270m box around WTG J08 (location below in Table 1).

Table 1: Location of J08

Coordinates

Easting

Northing

Latitude (DD.ddd)

Longitude (DD.ddd)

521647.35

6444909.30

58.144970

-2.632285

Latitude DMD

Longitude DMD

58.08.70N

002.37.94W

X-17

Call Sign:

MKMB4

MMSI:

232039414

Offshore Contact:

Anthony O’Toole (Marine Superintendent)

+353 1 223 9957

Anthony.otoole@xocean.com

Onshore Representative:

Deirdre Fahy (Project Manager)

+353 1 223 9988

Deirdre.fahy@xocean.com

1.       General Safety Advice

Please be aware that, during the survey activities, by virtue of its mode of operation the vessel X-17(Unmanned Surface Vessel) will be Restricted in her Ability to Manoeuvre (RAM) as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972, Rule 3). Masters of vessels are therefore requested to maintain their vessels and gears at a minimum safe passing distance from the vessel of 500 metres when it is undertaking work and showing the appropriate shapes and lights in accordance with COLREGs Rule 27.

In order to not compromise the safety of the Survey Vessel, their crew, and their ability to undertake its contracted works, fishermen who have static fishing gears deployed within 500 m from the WTG where survey activities are planned (see Table 1) are requested to provide the coordinates of such deployed gears in DMS and details of whether the surface markers used are visible at all states of visibility to Alex Winrow-Griffin (Brown & May Marine) using the contact information below (Section 58 of the Merchant Shipping Act 1995).

Fishermen who have static gears deployed beyond 12 nm are reminded that static gear must be marked in accordance with Commission Implementing Regulation (EU) No. 404/2011 (https://www.gov.uk/guidance/marking-of-fishing-gear-retrieval-and-notification-of-lost-gear#marking-of-fishing-gear)

2.       Contact details

The following contact can provide more information if required. Please note that specific queries can also be addressed to the relevant vessel or shore-based representative.

CONTACT DETAILS

Marine Coordination Centre 24/7 Marine Coordination – Duty MC Email mcc@morayeast.com

Tel : +44 07884630427

For fisheries related matters

Alex Winrow-Giffin – Brown and May Marine Ltd. Email: alex@brownmay.com

Tel : +44 1379 872148 / +44 7760 160039

See detailed map on our bulletin website
Show More

London Array - Export Cable Survey

Multi-beam bathymetry survey onboard the Spectrum 2, running the full length of each London Array Windfarm export cable.

Full multi-beam bathymetry survey of the 4 London Array export cables. The survey will commence out of Ramsgate with the vessel making its way around the headland for access to the export cables. The survey should take 10 days, exclusive of weather. The data will be acquired onboard the Spectrum 2, a 21m catamaran. Currently there is no towed equipment on the vessel (updates will be made to the notice if it is required).

See detailed map on our bulletin website
Show More

Floating LiDAR buoy deployment - Morecambe Offshore Windfarm

EOLOS intends to deploy a Floating LiDAR buoy (unit FL200 E35) to conduct a measurement campaign at the Morecambe Offshore Wind Farm. The campaign will last between 12 and 24 months, after which EOLOS will recover the buoy along with the entire mooring system.

Show More

East Anglia 3 Offshore Substation - Jack Up Barge

Mariners are advised that circa between 02/12/2025 and 06/12/2025, the Jack-up Barge (JUB) ‘JB 120’ will commence jacking up next to the East Anglia THREE Offshore Converter Station (OFCS) within the East Anglia THREE Windfarm array.

The jack-up vessel ‘JB 120’ will be positioned next to the East Anglia THREE OFCS within the East Anglia THREE Offshore Windfarm area.

  • Rig move: The vessel will be maneuvered to its designated location.
  • Jacking-Up Procedure: The vessel will be temporarily soft jacked on a safe stand-off position, from where its four anchors and mooring lines will be deployed. The deployed mooring lines will be used to move the vessel safely towards the final position, where the vessel will be jacked.
  • Operational Phase: Once jacked up, the vessel will remain stationary for an estimated six months.

During operations, the ‘JB 120’, ‘CENTAURUS’ (Lead tug), ‘FAIRPLAY 62’ (Assistant tug) and ‘FAIRPLAY 32’ (Assistant tug) will be restricted in their ability to manoeuvre as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessels will also transmit an Automatic Identification System (AIS) message.

A Statutory Safety zone of 500m radius will be in place around the ‘JB 120’ at all times.

‘JB 120’ and supporting tugs are supplied with VHF multi-channel radios and mobile phones.

See detailed map on our bulletin website
Show More

Seismic Survey - River Tyne

Mariners are advised that Fugro, on behalf of WSP, will be undertaking non-intrusive Geophysical and Seismic survey work in the River Tyne. This project is to investigate the seafloor and subsea floor ahead of a new underground cable being added to replace an existing overground cable.

Please be advised that on behalf of WSP UK Ltd, Fugro is planning to conduct a geophysical and seismic survey on the River Tyne. WSP requires seabed and sub-sea floor data ahead of a future project to replace an existing overhead power line with an underground tunnel.

The non-intrusive survey works shall be split into 2 passes, the first using 2D seismic towed equipment to provide sub-sea floor data. The second pass using Multibeam echo sounder (hull mounted), sub bottom profiler (vessel mounted) and side scan sonar (towed) to provide geophysical data.

See detailed map on our bulletin website
Show More

Loss of echosounder and clump weight at Salamander Offshore Wind Farm site

After multiple unsuccessful recovery attempts for the Flidar 1 anchor and the echosounder/clump weight from Salamander’s metocean campaign, the Project will not make any further attempts to locate and recover these items. These are now considered lost at sea, with the latest known seabed coordinates of each provided below. Note that these are deployed locations and they could have moved/been dragged from these points.

Echosounder and clump weight

A seabed mounted frame (1.6 x 1.6 m x 0.8 m, 350 kg) with echosounder inside was deployed in approx. 91 m water depth on 19th July 2024. The frame was connected with a ground line to a mooring weight/anchor (2,000 kg), which was attached to a standard spherical blue surface marker buoy with a riser to mark its position. The surface marker buoy was not visible at time of the first recovery attempt in January 2025 so is thought to have broken free from the clump weight. The frame was designed to be overtrawlable however the clump weight was not so could potentially pose a snag hazard.

Photos of the echosounder frame, clump weight and surface marker buoy are attached.

FLiDAR 1 anchor

In April 2024, the FLiDAR buoy broke its mooring; the clump weight for this was made up of several ~1m long lengths of heavy chain bound together with a smaller chain (photo of similar set-up attached as an example). The buoy and mooring were recovered, and subsequent inspection onshore showed that the chain binding the links of heavy chain had come apart as the FLiDAR was dragged, leaving the heavy chain lengths on the seabed. These are expected to have sunk into the seabed sediment and/or have dispersed from original location. Consequently, these links of chain are not considered to pose a snag risk.

Locations of these items are in table below but note that these are deployed locations and they could have moved/been dragged from these points.

Lost item

Latitude

Longitude

FLiDAR 1 anchor

DMS

57°36′28.8” N

1°13′37.2” W

DDM

57°36.480′ N

1°13.620′ W

Echosounder

DMS

57°36′17.6” N

1°13′35.2” W

DDM

57°36.294′ N

1°13.587′ W

Echosounder clump weight

DMS

57°36′20.0” N

1°13′36.0” W

DDM

57°36.334′ N

1°13.600′ W

See detailed map on our bulletin website
Show More

IAC Post Lay Burial (PLB) - Dogger Bank C

The Trenching Support Vessel, Assister, will perform Inter Array Cable Post-Lay Burial operations in Dogger Bank C Offshore Windfarm Area.

The campaign will commence on the 27th of September 2025 and continue until approximately 20th of October 2025. The works will be continuous, 24 hours a day. Charts of the DBC array area are provided below.

The operations include the post lay burial operations for part of the array cable routes, by means of jetting in order to protect the inter-array cables.

During operations, the Assister will be restricted in its ability to manoeuvre as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessel will also transmit an Automatic Identification System (AIS) message.

It is requested that all vessels maintain a minimum of 1.5Nm separation distance from the TSV and pass at reduced speed. Fishing gear or other equipment with seabed intervention should not be deployed when approaching the working corridor.

See detailed map on our bulletin website
Show More

Hornsea 3 Offshore Windfarm - Weekly Construction NtM

Notice to Mariners for construction activities associated with Hornsea Project Three Offshore Wind Farm. This notice will be updated weekly to provide insights into the project's activities throughout the construction phase.

Show More

Dogger Bank C Maintenance and Asset Preservation

The Service Operational Vessel, IWS Sun Walker, will carry out Balance of Plant (BoP) and Asset Preservation operations within Dogger Bank C construction site.

The works will be performed in a single campaign, commencing on the 7th of December 2025 and continuing until approximately Q4 2026. The works will be continuous, 24 hours a day. The operations will include visual inspections and remedial maintenance at the Offshore Substation Platform (OSP) and at installed WTG foundation locations. During operations, the IWS Sun Walker will be restricted in its ability to manoeuvre as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessel will also transmit an Automatic Identification System (AIS) message. It is requested that all vessels maintain a minimum of 500m separation distance from the SOV and pass at reduced speed. Fishing gear or other equipment with seabed intervention should not be deployed when approaching the working area.

See detailed map on our bulletin website
Show More

Aids To Navigation Demarcation Buoys - East Anglia THREE Offshore Windfarm

Mariners are advised that the Trinity House buoy Installation Vessel ‘Patricia’ has relocated four navigational buoys marking the boundary of the East Anglia THREE Offshore Windfarm.

THV Patricia has relocated the EA3 East 1 Buoy, EA3 East 2 Buoy, EA3 East Buoy 3 and the EA3 Special 3 Buoy marking the boundary of the East Anglia THREE Offshore Windfarm Array.

The demarcation buoys will remain on station throughout construction of the East Anglia THREE Offshore Windfarm.

For futher information regarding East Anglia THREE aids to navigation, please see attached EA3 Notice To Mariners 080- 2025 - Aids To Navigation – Demarcation Buoys.

See detailed map on our bulletin website
Show More

Unexploded Ordnance Target Investigation (Block 20-22, 26-39) - Eastern Green Link 2

Mariners are advised about Marine Survey Works for the Eastern Green Link 2 Project. Scottish Hydro Electric Transmission Plc and National Grid Electricity Transmission Plc are delivering the Eastern Green Link 2 (EGL 2) Project. The survey works for EGL 2 precedes the installation of an electricity transmission link from the East coast of Scotland (Sandford Bay, Peterhead) to the East coast of England (South of Bridlington/Flamborough Head) due to be completed in 2029.

EGL2 are due to commence an unexploded ordnance (UXO) target investigation ROV survey. The works are to be conducted within the Exclusion Blocks and updated coordinates are available on request.

The works consist of an ROV carrying out visual target investigation for the purposes of identifying potential unexploded ordnance. There will also be a small amount of debris recovery required depending on what is found during the investigations.

Works are being undertaken under an approved Marine Licence from the Marine Directorate (MS-00011033) and the approved Marine Licence from the Marine Management Organisation (L/2023/00211/2)

There will be no unexploded ordnance detonations performed; this is investigation works only.

See detailed map on our bulletin website
Show More

Unexploded Ordnance Target Investigation (Block 3-4) - Eastern Green Link 2

Mariners are advised about Marine Survey Works for the Eastern Green Link 2 Project. Scottish and Southern Electricity Networks Transmission and National Grid Electricity Transmission Plc are delivering the Eastern Green Link 2 (EGL 2) Project. The survey works for EGL 2 precedes the installation of an electricity transmission link from the East coast of Scotland (Sandford Bay, Peterhead) to the East coast of England (South of Bridlington/Flamborough Head) due to be completed in 2029.

EGL2 are due to commence an unexploded ordnance (UXO) target investigation ROV survey on the 14th of September 2025.

The works are to be conducted within the Exclusion Blocks shown by Figure 1, and updated coordinates are detailed in Table 1, both given below.

The works consist of an ROV carrying out visual target investigation for the purposes of identifying potential unexploded ordnance, small excavations on the seabed may also be undertaken to identify targets. There will also be a small amount of debris recovery required depending on what is found during the investigations.

The work is estimated to finish on approximately the 30th of December 2025, subject to weather.

Works are being undertaken under an approved Marine Licence from the Marine Directorate (MS-00011033) and the approved Marine Licence from the Marine Management Organisation (L/2023/00211/2)

There will be no unexploded ordnance detonations performed; this is investigation works only.

See detailed map on our bulletin website
Show More

Unexploded Ordnance Target Investigation (Blocks 1 -2) - Eastern Green Link 2

Scottish and Southern Electricity Networks Transmission and National Grid Electricity Transmission are delivering the Eastern Green Link 2 (EGL2) Project. The survey works for EGL2 precedes the installation of an electricity transmission link from the East coast of Scotland (Sandford Bay, Peterhead) to the East coast of England (South of Bridlington / Flamborough Head) due to be completed in 2029.

EGL2 are due to commence an unexploded ordnance (UXO) target investigation ROV survey on the 22nd of August 2025.

The works are to be conducted within the Blocks shown by Figure 1, and updated coordinates are detailed in Table 1, both given below.

The works consist of an ROV carrying out visual target investigation for the purposes of identifying potential unexploded ordnance, small excavations on the seabed may also be undertaken to identify targets. There will also be a small amount of debris recovery required depending on what is found during the investigations.

The work is estimated to finish on approximately the 30th of December 2025, subject to weather.

Works are being undertaken under an approved Marine Licence from the Marine Directorate (MS-00011033) and the approved Marine Licence from the Marine Management Organisation (L/2023/00211/2)

There will be no unexploded ordnance detonations performed; this is investigation works only.

See detailed map on our bulletin website
Show More

Vessel Traffic Survey - Thistle Wind Partners - Bowdun (E3)

The vessel KMS Karelle will be undertaking a Vessel Traffic Survey of the proposed Bowdun (E3) Offshore Wind Farm lease option area on behalf of Thistle Wind Partners (TWP). The survey is due to commence on 01 December, 2025. The survey is expected to be completed by 15 December, 2025, depending on weather.

A marine vessel traffic survey is due to be undertaken for the proposed Bowdun Offshore Windfarm project. The survey will be undertaken from one survey vessel, KARELLE, and will involve the collection of data of detected vessels and marine users through use of onboard radar, AIS and visual survey methods.

The survey will collect data within a proposed vessel roaming area within the project array area. The extent of the area in which the survey vessel may be located during the survey in the chart below. Coordinates of the survey area are also included.

The survey vessel will roam and/or remain nominally static within the area for approximately 14 days depending on weather conditions. The survey may be extended beyond 14 days depending on weather conditions, at which point further notification will be provided. Dates may be subject to change. The survey vessel will operate on a 24hr basis and display appropriate navigational lights at all times during operations.

See detailed map on our bulletin website
Show More

Unexploded Ordnance Technical Investigations (Blocks 42-56) Eastern Green Link 2

Helix is conducting UXO Target Investigations on behalf of the EGL2 subsea cable survey campaign. These investigations are conducted by an ROV. The survey area includes Survey Blocks 42-56. Investigations will commence on 6 December, 2025, subject to weather. The investigations are expected to be completed by 31 January, 2025, subject to weather.

Scottish Hydro Electric Transmission Plc and National Grid Electricity Transmission Plc are delivering the Eastern Green Link 2 (EGL 2) Project.

The EGL 2 project will play a vital role in achieving the UK and Scottish Government’s net zero targets and significantly increase the UK’s capacity for clean, green renewable power.

The survey works for EGL 2 precedes the installation of an electricity transmission link from the East coast of Scotland (Sandford Bay, Peterhead) to the East coast of England (South of Bridlington/Flamborough Head) due to be completed in 2029.

See detailed map on our bulletin website
Show More

Geophysical Survey Operations - Western Link Cable

Mariners are advised that a dedicated geophysical survey will be conducted at 14 locations on the existing Western Link cable route in the Firth of Clyde, North Channel, and northern Irish Sea. Survey operations are due to commence on 5th December 2025.

A detailed geophysical inspection survey at 14 areas along the route will be undertaken from the MV Scotia.

The survey will be conducted using a Remotely operated vehicle (ROV) with cable detection and Multibeam echosounder systems. Marine Mammal observations will be undertaken during the operations.

The operations are planned to be carried out from the 5th of December 2025 and could extend until the 20th December 2025.

The following considerations should be made regarding operational activities:

  • A safe distance of 0.5 nautical miles from the vessel must always be maintained.
  • It is also requested to establish contact with the Scotia (VHF 16) to obtain information on the planning and to allow a coactivity on the zone without obstructions.
  • It is requested that the work area be kept clear of fishing gear to avoid entanglement.
  • The Scotia may have an ROV (remotely operated vehicle) deployed Subsea beneath the vessel and be restricted in manoeuvrability.
  • The vessel will display all applicable lights and shapes.

See detailed map on our bulletin website
Show More

Marine Works - MeyGen Tidal Array

Mariners are advised that subsea works are to be conducted at the MeyGen Tidal Array site.

The vessel Normad Vision, call sign LAQR7, will enguage in subsea works at the Meygen tidal array, located in the Inner sound of the Pentlnd Firh.

The vessle will be undertking subsea works in the slack tide durations supproted by WCROV.

The works will also incldue cable handlnig with the vessel secured to the asset between slack tides.

See detailed map on our bulletin website
Show More

Maintenance of EA3 Weather Monitoring Buoys - East Anglia Three Offshore Windfarm

Please be advised that Partrac Ltd will be undertaking maintenance on the two weather monitoring buoys that have been deployed within the East Anglia Three Offshore Windfarm area. Partrac will utilise the vessel ‘Isle of Jura’ for maintenance of these buoys.

It is currently anticipated that weather permitting, works will commence circa the 28/11/2025. The weather buoys will remain on station throughout the construction phase of the East Anglia THREE Offshore Windfarm.

Completion of maintenance works will be notified by future Notice to mariners.

See detailed map on our bulletin website
Show More

Scottish Nearshore Geotechnical Survey - Peterhead - Eastern Green Link 2

Geotechnical Drilling (boreholes) survey using a jack up barge and support vessels to evaluate underlying geology. The support vessels will be providing crew change and pushing services to the Shearwater Jack Up Barge. These activities will occur in an active Exclusion Zone, within which other surveys have been taking place.

Mariners are advised about Marine Survey Works for the Eastern Green Link 2 Project. Scottish Hydro Electric Transmission Plc and National Grid Electricity Transmission Plc are delivering the Eastern Green Link 2 (EGL 2) Project. The EGL 2 project will play a vital role in achieving the UK and Scottish Government’s net zero targets and significantly increase the UK’s capacity for clean, green renewable power. The survey works for EGL 2 precedes the installation of an electricity transmission link from the East coast of Scotland (Sandford Bay, Peterhead) to the East coast of England (South of Bridlington/ Flamborough Head) due to be completed in 2029.

See detailed map on our bulletin website
Show More

Metocean Equipment - Bowdun Offshore Wind Farm

Partrac Ltd., on behalf of Thistle Wind Partners, is servicing metocean equipment (LiDAR Buoy) within the Bowdun Offshore Wind Farm site. The servicing of the metocean equipment is estimated to be carried out over three days on a weather window starting on the 3rd of August 2025, weather permitting, using the vessel Forth Constructor.

The following equipment will be recovered, maintained, and redeployed on the site for the duration of the project:

  • 1 x Floating LiDAR (FLS)
  • 1 x Subsea mooring
  • 1 x Wave buoy
  • 1 x Guard buoy

Maintenance activities will include but not be limited to:

  • Visual Inspection, testing and replacing components as required.
  • Cleaning & regreasing
  • Replace batteries.
  • Data download

All vessels are requested to maintain a 500m exclusion zone around the location.

See detailed map on our bulletin website
Show More

Jack up campaign - 2 x Generator exchanges - Greater Gabbard Offshore Wind Farm

Jack up campaign for 2 assets approximately starting on the 6th December 2025

Latest information as per NTM-014-2025 2 x generator exchanges on IGD07 and GAD10

The Jack up WIS (windserver)  will come to complete the above around 6th December then leave site

It is then expected to return around the 12th Jan for a larger campaign currently with an additional 5 assets - TBC

I am unable to uplaod the NTM however this has been distributed

See detailed map on our bulletin website
Show More

LT360 Spittal to Peterhead Nearshore Geotechnical Investigation (Rattray Head and Sinclair’s Bay)

Fugro on behalf of Scottish and Southern Electricity Networks Transmission (SSENT) are conducting nearshore Geotechnical borehole investigations at both Sinclair's Bay, Wick and Rattray Head, Peterhead. Marine works are planned between 01/12/25 and 31/01/26.

Mariners are advised that from 01/12/25 to 31/01/26, Fugro jack-up barge (JUB) “WaveWalker 1” will be performing nearshore geotechnical borehole investigations. This will be conducted on behalf of the client Scottish & Southern Electricity Networks Transmission (SSENT).“WaveWalker 1” will be towed between sites and supported throughout by anchor handling tug/utility vessel “Elisa”. Work sites for “WaveWalker 1” are at Rattray Head (north of Peterhead) and Sinclair’s Bay (Caithness). A decision on which site will be sequenced first is to be made during tow following mobilisation in Great Yarmouth.At each site three (3) number boreholes will be drilled in order to assess geological conditions. Approximate borehole locations are between 400m and 1,200m from shore.A 500m exclusion zone will be enforced around the JUB at all times. Vessels are to take caution when navigating in this area and pass well clear of the JUB. Earliest start (either site) is 1st December 2025. Precise date dependent on progress of tow from mobilisation in Great Yarmouth which is weather sensitive. This notice may be updated when the worksite sequence is known and / or arrival date better defined.Following completion of operations at first site, the JUB will be towed to the second.

See detailed map on our bulletin website
Show More

Wet storage of cut length of steal wire rope - East of Sandford Bay-Eastern Green Link 2

Following the EGL2 offshore UXO TI Campaign along the EGL2 survey corridor, SHET and NGET are advising Mariners of wet storage of a cut length of steel wire rope (SWR) outside of Sandford Bay. The remainder of the wire is assumed to be buried beneath the seabed. The wire does not constitute a hazard to general navigation; however, it may present a risk to small vessels when anchoring or operating gear in the immediate vicinity.

Details:

· The SWR section is assumed to be a remnant of discarded trawl wire or anchor cable.

· The wire does not pose a hazard to general navigation.

· However, it may present a risk to small vessels when anchoring or operating gear near the seabed in close proximity to the locations detailed in the table below.

· There was an extensive length/volume of SWR recovered during UXO TI investigations. The Glomar Wave was not able to safely bring this on deck, so it was placed atop the SWR that it was connected to.

· SWR was placed here for wet store until further notice.

See detailed map on our bulletin website
Show More

Western Link 2 Metocean Acoustic Doppler Current Profiler (ADCP) Deployments at Girvan and Troon

Please be advised that Fugro, on behalf of the Western Link 2 (WL2) HVDC subsea electricity transmission cable project survey campaign, will be deploying metocean Acoustic Doppler Current Profilers (ADCP) on the sea floor at two locations, one at Girvan and one at Troon. Please see equipment description, project description, positions, and support vessel details in the attached Notice to Mariners document.

The metocean ADCP seabed frame deployment for WL2 is due to commence on 08/09/2025, subject to weather. The ADCPs are expected to be recovered by 15/12/2025, subject to weather. The ADCP seabed frames are weighted objects with imbedded sensors, which sit passively on the seafloor to collect environmental data, including current profiles, turbidity, and temperature measurements at the sites of deployment. One ADCP will be deployed approximately 3.4 km northwest of Girvan. The other ADCP will be deployed approximately 3.5 km west of Troon. The ADCPs will be deployed and serviced by the support vessel, 'CT Barnston.' The vessel will mobilise at the Port of Troon.

See detailed map on our bulletin website
Show More

Western Link 2 Metocean Acoustic Doppler Current Profiler - Irish Sea

Please be advised that Fugro, on behalf of the Western Link 2 (WL2) HVDC subsea electricity transmission cable project survey campaign, will be deploying a metocean Acoustic Doppler Current Profiler (ADCP) on the sea floor in the Irish Sea. The ADCP seabed frame will be deployed approximately 35 km southwest of the Isle of Man, and approximately 42 km northwest of Anglesey. Please see equipment description, project description, position, and support vessel details in the attached document.

The metocean ADCP seabed frame deployment for WL2 is due to commence on 05/09/2025, subject to weather. The ADCP seabed frame is expected to be recovered by 15/12/2025, subject to weather. The ADCP seabed frame is a weighted object with imbedded sensors, which sit passively on the sea floor to collect environmental data, including current profiles, turbidity, and temperature measurements at the site of deployment. The ADCP will be deployed and serviced by the support vessel, 'CT Barnston.' The Vessel will mobilise at the Port of Holyhead.

The Western Link 2 subsea cable project is being developed by Scottish Power Energy Networks Plc and National Grid Electricity Transmission Plc.

See detailed map on our bulletin website
Show More

Western Link 2 Metocean Acoustic Doppler Current Profiler - Caernarfon Bay

Please be advised that Fugro, on behalf of the Western Link 2 (WL2) HVDC subsea electricity transmission cable project survey campaign, will be deploying a metocean Acoustic Doppler Current Profiler (ADCP) on the sea floor in Caernarfon Bay, just outside of the harbour boundary. Please see equipment description, project description, position, and support vessel details in the attached document.

The metocean ADCP seabed frame deployment for WL2 is due to commence on 05/09/2025, subject to weather. The ADCP seabed frame is expected to be recovered by 15/12/2025, subject to weather. The ADCP seabed frame is a weighted object with imbedded sensors, which sit passively on the sea floor to collect environmental data, including current profiles, turbidity, and temperature measurements at the site of deployment. The ADCP will be deployed and serviced by the support vessel, 'CT Barnston.' The Vessel will mobilise at the Port of Holyhead.

The Western Link 2 subsea cable project is being developed by Scottish Power Energy Networks Plc and National Grid Electricity Transmission Plc.

See detailed map on our bulletin website
Show More

Bathymetric Survey - Galloper Windfarm

Galloper Windfarm Bathymetric Survey on four locations / array cables between OSP and 4 x WTG locations by Survey Vessel Northern Storm commencing 26th November

Galloper Windfarm Bathymetric Survey on four locations / array cables between OSP and 4 x WTG locations by Survey Vessel Northern Storm commencing 6th November

See detailed map on our bulletin website
Show More

Geophysical Survey Operations - Eastern Green Link 5 Project

Mariners are advised that a geophysical survey is planned for the Eastern Green Link 5 (EGL 5) project. The marine survey activities for EGL 5 are planned to commence on the 23rd of November 2025 and are expected to complete approximately mid-January 2025.

Mariners are advised that a geophysical survey is planned for the Eastern Green Link 5 (EGL 5) project. The marine survey activities for EGL 5 are planned to commence on the 23rd of November 2025 and are expected to complete approximately mid-January 2025. SSEN Transmission and National Grid Electricity Transmission (NGET) are working together to address the need for increased capacity within the transmission network between Scotland and England. EGL5 will help provide increased capacity, carrying up to 2 GW of electricity, enough for two million homes. This will be achieved through a High Voltage Direct Current (HVDC) cable connection between Aberdeenshire and Lincolnshire.The EGL 5 geophysical survey works are being carried out by Ocean Infinity Limited.The area of work, pertaining to this Notice to Mariners (NtM) for EGL 5, is highlighted in Figure 1, with the survey vessels contact details for the project found in Table 1. Contact details for the project Fisheries Liaison Officers (FLO) are detailed below.

See detailed map on our bulletin website
Show More

Research Buoy Deployment Extension Notification - Morlais Demonstration Zone.

Research Buoy Extension Notification - Morlais Demonstration Zone.

The Marine Characterisation Research Project (MCRP) is an innovative research and development project that will ensure the safe phased deployment of tidal
energy turbines in the Morlais Demonstration Zone (MDZ). Working with a team of experts, the project are developing an Environmental Monitoring and Mitigation Plan to safeguard marine wildlife. The findings will subsequently be available for future marine renewable energy projects to enable the growth of tidal stream energy.

The aim of the project is to facilitate environmental data collection, and support research and development of turbine centred monitoring and mitigation devices. The knowledge gained will enable the safeguarding of wildlife during the development of the MDZ.

To best exploit the opportunity available to gather valuable and relevant information, the MCRP procured a scientific lidar research buoy, upon which the MCRP have deployed data collection equipment, in order to gather baseline data from the MDZ and test the equipment.

Following a successful refit in the port of Holyhead during November 2024, the Marius buoy had been redeployed in the Morlais zone for a further 12-month period of data collection.

Following this the decision has been made to extend the deployment for a further 6 month period to support refinement of the technologies, and enable in situ demonstration.

See detailed map on our bulletin website
Show More

Seabed Preparation - Inch Cape Offshore Wind Farm and export cable corridor

All mariners and stakeholders are advised that seabed preparation activities will continue within the Inch Cape Offshore Wind Farm and export cable corridor. N-Sea Pathfinder will join the boulder relocation works.

On behalf of Inch Cape Offshore Ltd, N-Sea will continue seabed preparation activities within the wind farm site boundary and its export cable corridor. Initially boulder clearance will focus on the wind farm site with clearance in the export cable 2 route commencing in the new year on a date to be confirmed.

Seabed preparation includes the relocation of any boulders which may affect the installation of offshore structures, inter-array cables and export cables.

The boulder relocation vessel, FS Aries will be joined by N-Sea Pathfinder on or around Wednesday the 27th of November.

See detailed map on our bulletin website
Show More

Major Component Repairs at Moray East Wind Farm - K17

Please be advised that Moray Offshore Windfarm (East) Limited (Moray East) are planning to commence major component repairs on a Wind Turbine Generator (WTG). These activities will be undertaken using the Jack-up vessel Deme Apollo, detailed below. Activities are expected to take place between 01/12/2025 and 01/01/2026 subject to weather.

Please be aware that, during the major repair activities, by virtue of its mode of operation the Jack-up vessel will be Restricted in her Ability to Manoeuvre (RAM) as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972, Rule 3). Masters of vessels are therefore requested to maintain their vessels and gears at a minimum safe passing distance from the vessel of 500 metres when it is undertaking work and showing the appropriate shapes and lights in accordance with COLREGs Rule 27.In order to not compromise the safety of the Deme Apollo and their crew, and the ability to undertake its contracted works, fishermen who have static fishing gears deployed within 500 m from the WTG where major repairs are planned are requested to provide the coordinates of such deployed gears in DMS and details of whether the surface markers used are visible at all states of visibility to Alex Winrow-Griffin (Brown & May Marine) using the contact information below (Section 58 of the Merchant Shipping Act 1995).Fishermen who have static gears deployed beyond 12 nm are reminded that static gear must be marked in accordance with Commission Implementing Regulation (EU) No. 404/2011

The Scottish Ministers have authorised the establishment of a 500-metre radius safety zone around all major maintenance works being undertaken. The safety zones will be active when the jack-up vessel involved in undertaking major maintenance works is attached to, or anchored next to, the renewable energy installation. No more than one 500 metre major maintenance safety zone will be active at any given time.All mariners are requested to give a wide berth to all vessels involved in the major repair activities.Mariners are requested to navigate with caution, to use all means appropriate to aid safe navigation as defined under COLREGs Rule 7, and keep continued watch on VHF Ch. 16, 87 and 73 when navigating the area.

See detailed map on our bulletin website
Show More

Windea Clausius (OFCS Platform Commissioning Service Operation Vessel) - East Anglia THREE Windfarm

Please be advised that the Commissioning Service Operation Vessel (CSOV) ‘WINDEA Clausius’ is expected to mobilise from the port of Emden circa the 24/11/2025. Earliest arrival at East Anglia THREE site circa 25/11/2025, The main working area is within the East Anglia THREE Offshore Windfarm area set out in section 2.1 of the attached document.

The CSOV ‘WINDEA Clausius’ provides accommodation and Walk-to-Work access for the commissioning phase of the East Anglia THREE Offshore Converter station (OFCS) ‘EA3 OFCS’. ‘WINDEA Clausius’ will be deployed inside East Anglia THREE Windfarm and is equipped with VHF multi-channel radios and mobile phones.Outer Thames Estuary Special Protection Area (SPA):As required under Deemed Marine License Condition 13(1)(c)(v) to minimise disturbance to red throated diver in the Outer Thames Estuary Special Protection Area (SPA) during construction of East Anglia THREE, these areas shall as far as practicable be avoided during transits from 01st November to 31st March.

See detailed map on our bulletin website
Show More

Export Cable Installation - East Anglia THREE Offshore Windfarm

Mariners are advised that NKT will conduct cable installation through Simultaneous Laying and Burial (SLB) along the East Anglia THREE export cable corridor. NKT will utilise the vessel ‘NKT VICTORIA’ for cable laying operations. All marine traffic is advised to maintain a 1000m safety zone around ‘NKT Victoria’ during operations and pass at a reduced speed.

SLB will be conducted between KP4.0 – KP148.0, Inspection operations will be performed at third-party asset locations where applicable.

During operations, NKT Victoria will have restricted manoeuvrability as defined under COLREGs (International Regulations for Preventing Collisions at Sea, 1972). The vessel will display appropriate day shapes and lights and will transmit an Automatic Identification System (AIS) message.‘NKT Victoria’ will monitor VHF Channel 16 and VHF DSC Channel 70 continuously throughout the operation.

It is currently anticipated that, weather permitting, works will be conducted on a continuous basis (i.e., 24-hour working, seven days a week).

For further information regarding export cable installation operations, please see attached East Anglia THREE Notice To Mariners: EA3 NTM 53/2025- Export Cable Installation.

See detailed map on our bulletin website
Show More

Pre Installation Survey Campaign 3 - East Anglia THREE Offshore Windfarm

Mariners are advised that circa the 01/12/2025, Geo Ocean IV will conduct a Pre-Installation Survey Campaign within the East Anglia THREE Offshore Windfarm Area. During the period of Pre-Installation Survey, all vessels are requested to keep a 500m safety distance from the Geo Ocean IV.

GEOxyz will utilise the ‘Geo Ocean IV' to perform a Pre-Installation Survey within the East Anglia THREE Offshore Windfarm.The vessel will conduct Multibeam Echo Sounder (MBES) and Side Scan Sonar (SSS) surveys of the Wind Turbine Generator foundation locations, at a radius of 170m.

The Multibeam Echo Sounder is hull mounted and the Side Scan Sonar is towed from the stern of the vessel at a height of 6.5m to 10m above the seabed.

GeoOcean IV will monitor VHF Channel 16 and VHF DSC Channel 70 continuously throughout the operation. It is currently anticipated that weather permitting, works will be carried out on a continuous basis (i.e.,24- hour working, seven days a week) unless notified otherwise.

For further information regarding Pre Installation Survey Campaign 3, please see attached East Anglia THREE Notice To Mariners: EA3 NTM 077/2025 Pre-Installation Survey Campaign 3.

See detailed map on our bulletin website
Show More

Acoustic Monitor Array Deployment - Inch Cape Offshore Wind Farm

All mariners and stakeholders are advised that during Passive Acoustic Monitoring (PAM) mooring array servicing, three items have been dropped to the seabed. These items are close inshore in the vicinity of Montrose Bay and Broughty Ferry. The service campaign shall continue as weather conditions allow.

All mariners and stakeholders are advised that during Passive Acoustic Monitoring (PAM) array servicing, three objects were dropped overboard from the vessel, it’s unclear whether these items will be recoverable, these items are close inshore in the vicinity of Montrose Bay and Broughty Ferry.

Object 1 is a 25cm hydrophone, Object 2 consists of 4 x 20kg weights, acoustic release equipment and 50m of 4mm dyneema rope, Object 3 is an acoustic release canister, 4 x 20kg weights and 36m of 4mm dyneema rope. This rope may constitute a hazard to small craft.

The servicing campaign shall resume as weather conditions allow.

Table 1 -Dropped Object coordinates.

No

Location

Dropped Coordinates

1

Montrose – Object 1

56°43.466’N 002°23.783’ W

2

Montrose – Object 2

56°41.413’ N 002°25.037’ W

3

Broughty Ferry – Object 3

56°27.213’ N 002°50.956’ W

See detailed map on our bulletin website
Show More

Confirmed Unexploded Ordnance - East Anglia THREE Offshore Windfarm

Please be advised that confirmed Unexploded Ordnance has been identified at the following locations. All vessels are advised to navigate with caution and keep clear of highlighted positions by a 300m radius. Please see attached notice to mariners for further information regarding exclusion zones.

Confirmed Unexploded Ordnance within the East Anglia Three CDM boundaries of the offshore windfarm array and export cable route.

See detailed map on our bulletin website
Show More

Esvagt Carpathia (OFCS ERRV) - East Anglia THREE Offshore Windfarm Array

Mariners are advised that Emergency Response and Rescue Vessel (ERRV) ‘ESVAGT Carpathia’ is expected to mobilise from the port of Lowestoft. All vessels are requested to keep a 500m safety distance from the ‘ Esvagt Carpathia’ whilst carrying out operations within the East Anglia THREE Offshore Windfarm Array.

The ERRV ‘ESVAGT CARPATHIA’ provides relief duties for standby emergency rescue services during thecommissioning phase of the East Anglia THREE Offshore Converter station (OFCS) ‘EA3 OFCS’. The ESVAGT CARPATHIA will be required to cover these duties when the primary Emergency Response Rescue Vessel 'ESVAGT CARTPATHIA' conducts port calls for crew changes and resupplies.

It is currently anticipated that weather permitting, operations will be carried out on an on-demand basis (i.e.weekly, bi-weekly, ad hoc).Arrival and departure plan of the 'ESVAGT CARTPATHIA' will be notified via the East Anglia THREE Weekly Noticeof Operations.Completion of the 'ESVAGT CARTPATHIA’s' work scope will be notified by closure of this Notice to Mariners.All vessels will continuously monitor VHF Channel 16 and VHF DSC Channel 70 throughout operations.It is currently anticipated that weather permitting, works will be carried out on a continuous 24-hour basis,seven days a week, unless notified otherwise.

See detailed map on our bulletin website
Show More

Cable exposures - Q&E North Cable System

Q&E North Cable System has become exposed at the following locations

Please be advised that the Q&E North Cable System has become exposed at the following locations:

51° 22.5823’ N  2° 0.5343 E

51° 22.5948’ N  2° 0.7922 E

51° 22.5963’ N  2° 0.8562 E

All seabed users are politely requested to avoid this area due to the risk of snagging any equipment engaging with the seabed.

See detailed map on our bulletin website
Show More

Geophysical Survey - Western Link 2 Offshore

Mariners are advised that Fugro, on behalf of Western Link 2 (WL2), will be undertaking survey work in the water depths greater than 50 m in the survey corridor, from the the Firth of Clyde at the northern end, through the North Channel, and into the Irish Sea at the southern end. Scottish Power Energy Networks and National Grid Electricity Transmission Plc are delivering the WL2 Subsea cable Project. WL2 will play a vital role in achieving UK, Welsh and Scottish Governments’ net zero targets.

The marine survey activities for WL2 have commenced on 28/09/2025, subject to weather. The survey is due to be completed by 15/12/2025, subject to weather.

The offshore work is to be conducted within the area exhibited in Figures 1-5, and updated coordinates are detailed in Tables 1, 2, and 3. The marine works consist of geophysical and crossings surveys. The geophysical surveys will be conducted by the vessels Fugro Galaxy and Fugro Kommandor Iona, and will consist of both hull mounted and towed systems. The crossings surveys will be conducted by the vessel Fugro Scotia. There is no intrusive work planned.

See detailed map on our bulletin website
Show More

Commencement of Inch Cape Generating Station Construction Activities

All mariners and stakeholders are advised that Generating Station construction activities will commence within the Inch Cape Offshore Wind Farm.

Inch Cape Offshore Ltd Generating Station (GS) construction activities will commence within the Inch Cape Offshore Wind Farm on or around the 15th of December 2025. The GS construction activities include installation of Wind Turbine Generator (WTG) Foundations, Inter Array Cables (IAC) and WTGs.

These GS construction activities follow on from the Offshore Transmission Infrastructure (OfTI) - export cables, and offshore substation platform construction activities - which commenced earlier in the year (commencement of OfTI works notified by ICOL in NTM reference 2/2025).

The GS construction activities will commence initially with WTG Foundation monopiles installation at the array site, managed on ICOL’s behalf by Jan De Nul and IQIP. Other GS construction activities to follow.

Further Notices to Mariners detailing individual GS work scopes will be promulgated prior to works starting.

These GS construction activities will also be added to Weekly Notices of Operations including a project vessel report. These Weekly Notices will be promulgated to stakeholders and posted on the Inch Cape website, please visit www.inchcapewind.com

Offshore construction activities are expected to be completed by late 2027.

See detailed map on our bulletin website
Show More

Post-Lay Mattress Installation - East Anglia THREE Export Cable Corridor

Mariners are advised that circa the 14/11/2025, Mattress Installation vessel ‘Olympic Taurus’ will transit to and commence Post-Lay Mattress Installation within the East Anglia THREE Export Cable Corridor as detailed in section 2.1 of this document

NKT will conduct Post-Lay Mattress Installation along the East Anglia 3 export cable corridor in the North Sea using the vessel Olympic Taurus. The work will be performed in a single campaign with up to 3 planned loads. Post-lay protection, consisting of concrete mattresses and rock filter units, will be placed on the export cable at third party asset crossings and remedial locations. In/out surveys will be performed prior to and following placement.

It is requested that all vessels maintain a minimum of 1.5Nm separation distance from Olympic Taurus and pass at reduced speed.

 Fishing gear or other equipment with seabed intervention should not be deployed when approaching the working corridor.

See detailed map on our bulletin website
Show More

Rock Bag Installation - East Anglia THREE Offshore Windfarm

Mariners are advised that Grand Canyon III will conduct Rock bag Filter Unit deployment operations within the East Anglia THREE Offshore Windfarm area set out in section 2.1 of this document. During the period of RFU operations, all vessels are requested to keep a 500m safety distance from the Grand Canyon III at all times

Rock Filter Units (RFUs) will be over boarded from the Grand Canyon III and will wet store circa 400 x 8Te RFU’sacross the East Anglia THREE Offshore Windfarm area set out in section 2.1

Program Schedule:

Grand Canyon III is expected to mobilize from the port of Blyth circa 14/11/2025 and expected to commenceloading operations from the Port of Great Yarmouth Circa 15/11/2025. Completion of Works will be notified by thecancellation of this Notice to Mariners.

Grand Canyon III will monitor VHF Channel 16 and VHF DSC Channel 70 continuously throughout the operations.It is currently anticipated that weather permitting, works will be conducted on a continuous basis (i.e.,24- hourworking, seven days a week) unless notified otherwise.

See detailed map on our bulletin website
Show More

Geotechnical Survey Operations - Eastern Green Link 5 Project

Mariners are advised that a geotechnical survey is planned for the Eastern Green Link 5 (EGL 5) project. The marine survey activities for EGL 5 are planned to commence on the 23rd of November 2025 in English waters working north and are expected to complete approximately end of February 2026.

SSEN Transmission and National Grid Electricity Transmission (NGET) are working together to address the need for increased capacity within the transmission network between Scotland and England. EGL5 will help provide increased capacity, carrying up to 2 GW of electricity, enough for two million homes. This will be achieved through a High Voltage Direct Current (HVDC) cable connection between Aberdeenshire and Lincolnshire.

The EGL 5 geotechnical survey works are being carried out by Ocean Infinity Limited.

The area of work, pertaining to this Notice to Mariners (NtM) for EGL 5, is highlighted in Figure 1, with the survey vessels contact details for the project found in Table 1. Contact details for the project Fisheries Liaison Officers are detailed below.

Please note, this survey will be able to operate around static fishing gear. Therefore, fishing gear clearance is not being requested.

Navigational Safety Advice

Vessels are requested to pass at a safe speed and distance and fishing vessels are advised to remain a safe distance, approximately 550m (0.3 nautical miles) from the areas identified. During these works the vessel will have restricted manoeuvrability as it completes its work scope.

VHF CH 16 will be monitored at all times and will be used to contact the coastguard in the event of an emergency.

Survey Vessels

The geotechnical survey works are being carried out by Ocean Infinity Limited using the following vessels:

Survey vessel: A7803 (IMO 9924261; MMSI 563175900; Call Sign 9V8529)

See detailed map on our bulletin website
Show More

Cable Exposures - HVDC cable in the Thames Estuary

Recent surveys have discovered 2 exposures on an HVDC cable in the Thames Estuary.

The westerly exposure is 26m long, the easterly is 27m long.

See detailed map on our bulletin website
Show More

UXO marine geophysical survey - Eastern Green Link 3

Eastern Green link 3 are currently carrying out a UXO marine geophysical survey near Sandford Bay using the vessel Spectrum 1. The marine survey activities for EGL 3 are planned to commence on the 29 September 2025 and are expected to complete around the end of December 2025.

Mariners are advised that a UXO marine geophysical survey is planned for the Eastern Green Link 3 (EGL 3) project. The marine survey activities for EGL 3 are planned to commence on the 29 September 2025 and are expected to complete around the end of December 2025.

EGL3 is a HVDC electricity transmission interconnector between Scotland and England, a joint venture between National Grid and Scottish & Southern Electricity Networks ((SEN) Transmission.

The EGL 3 project will play a vital role in achieving the UK and Scottish governments net zero targets and significantly increase the UK’s capacity for clean, green renewable power.

The EGL 3 UXO marine survey works are being carried out by Spectrum Geosurvey Limited.

See detailed map on our bulletin website
Show More

Wave Rider Buoy - East Anglia THREE Offshore Windfarm

Mariners are advised that Seaway 7 have deployed a Wave Rider Buoy within the East Anglia THREE Offshore Windfarm Area

Seaway 7 deployed a Wave Rider Buoy on the 01/05/2025 within the boundary of the East Anglia THREE Offshore Windfarm Array during the Monopile Noise monitoring campaign as referenced in EA3 NTM 026 - 2025 Monopile Installation (Noise Monitoring Buoy Deployment). The Wave rider Buoy will remain on station until the end of the project.

The Wave Rider Buoy is equipped with a flashing yellow light and has a range of four nautical miles.

Recovery and/or periodic maintenance of the Wave Rider Buoy will be notified via future Notice to Mariners

See detailed map on our bulletin website
Show More

UXO ID and Clearance Campaign - East Anglia 2 Export cable corridor

Scheduled potential UXO investigation works are due to commence along EA2 Export cable corridor and offshore wind farm CDM area. These works will be carried out using the Glomar Worker, Ross Eagle and Tor Boreas vessels. The Glomar Worker and Ross eagle will be mobilised with WROVs to investigate targets and Tor Boreas will be a dive support vessel identifying targets closer to shore. Investigation operations will be carried out between September 2025 and December 2025.

Scheduled potential UXO investigation works are due to commence along EA2 Export cable corridor and offshore wind farm CDM area. These works will be carried out using the Glomar Worker, Ross Eagle and Tor Boreas vessels. The Glomar Worker and Ross eagle will be mobilised with WROVs to investigate targets and Tor Boreas will be a dive support vessel identifying targets closer to shore.  Investigation operations will be carried out between September 2025 and December 2025.

Scheduled vessel dates are as follows...

Glomar worker mobilise on 14/09 - completing Dec 25

Ross Eagle mobilising on 17/09 - completing Dec 25

Tor Boreas dive support vessel mobilising on 20/09 - completing Dec 25

The Glomar Worker and Ross Eagle will identify targets in the OWF & ECR and Tor Boreas will identify targets nearer to shore.

See detailed map on our bulletin website
Show More

Subsea Rock Installation - Dogger Bank A, B & C Offshore Wind Farm

Fall Pipe Vessel (FPV) Rollingstone will continue with subsea rock installation at various locations on Dogger Bank A, B and C

Rollingstone will start operations on 14th of November 2025 and will perform rock placement during multiple load-outs, finishing her scope around 31st of December 2025. Work will be continuous, 24 hours a day. Coordinates of the DBA, DBB and DBC are presented in Tables below.

During operations, Rollingstone will be restricted in their ability to manoeuvre, as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessel will also transmit an Automatic Identification System (AIS) message.

It is requested that all vessels maintain a minimum of 500m separation distance from the Rollingstone and pass at reduced speed.

See detailed map on our bulletin website
Show More

XOCEAN Cable Route Survey - Lancashire Coast

Activity: Operations of remotely piloted Uncrewed Surface Vessel (USV) are planned off the Lancashire Coast. Dates: Between 10/11/25 to 15/12/2025, subject to weather conditions, for approximately three consecutive days.

One (1) USV will be mobilised from Fleetwood, where the USV will transit to the areas of operation. During the operations, the USV will be performing a Hydrographic Survey of the areas specified in the figure below, within the 12nm limit.Support vessels will escort the USV from the harbour entrance and will then continue transiting towards the survey site until the area is safe & clear of hazards. Once the survey is complete, the USV will return to Port, again with a support vessel as an escort.It is requested that other vessels remain clear, so far as is practicable, during transit & survey operations.Although the vessel is uncrewed, it is managed throughout the 24-hour operation, piloted remotely using 360 degree cameras and other navigational aids.

See detailed map on our bulletin website
Show More

Accidental Deposit of an Object at Sea - Seabed Frame

Seabed Frame unable to be recovered from deployed location - risk of snagging, alert to all marine users.

During recovery operations following completion of metocean data collection at the Muir Mhor site, the seabed frame was unable to be recovered. Seabed frame recovery was not possible due to transponder onboard vessel being unable to make a connection with acoustic receiver on the seabed frame. It is not yet confirmed whether the seabed frame is in the deployed location and is simply damaged, or whether it has been moved.

See attached photo for details of the frame.

Last known location of the seabed frame is the deployed location as per coordinates given in this notice.

Report has been made to Marine Directorate on 22/07/2025. Further updates on recovery will be posted to this notice.

Search and recovery scheduled for November 2025.

See detailed map on our bulletin website
Show More

UXO - Greater Gabbard windfarm

A UXO was found and is currently sitting in position 51'57.924'N 001'56.122'E as per NTM. This is inside the Greater Gabbard windfarm - we have no plans to remove/ move/ detonate. This has been surveyed and the risk of detonation is low however we would advise a 500m Exclusion zone

Show More

Cable Exposure - Export Cable Route - Sofia Offshore Wind Farm

Mariners are advised that a subsea survey carried out in July/August 2025 has identified multiple cable exposures along a 120km section the Sofia Export Cable Route. Fishing restrictions therefore continue to apply within the Sofia OWF export cable exclusion boundaries. The guard vessel 'Enterprise II' continues monitoring operations within the Sofia Export Cable Corridor between KP4 & KP90.

Sofia OWF are currently evaluating the exposure risks and will update accordingly.

At this this time, it is important to note that the cable is sensitive to any external impact and constitutes a SUBSEA SNAGGING RISK for anchoring, fishing gear or other equipment with seabed intervention. Seabed activities should be avoided within the designated area until further notice.

The Guard Vessel “Enterprise II” shall be monitoring VHF 16 during their scope of the works.

See detailed map on our bulletin website
Show More

HVAC Link Project - Orkney Caithness

Scottish & Southern Electricity Networks (SSEN) wish to inform Mariners of the completion of marine works in the near-shore area off Warbeth, Orkney which forms part of the Orkney -Caithness HVAC Link Project. As a result two subsea structures are now located on the sea bed.

Scottish & Southern Electricity Networks (SSEN) wish to inform Mariners of the completion of marine works in the near-shore area off Warbeth, Orkney which forms part of the Orkney -Caithness HVAC Link  Project.  The completion of this work includes the installation of two subsea assets in the form of two ducts and associated rock bags approx 1km SW of Warbeth Beach, Orkney and have been placed with in the boundaries of the  4 points and associated coordinates  detailed in the attached NTM. The works have resulted in a reduction in charted water depth.

 Mariners are advised to stay well clear of the area as detailed until further notice.

See detailed map on our bulletin website
Show More

CTV NR Predator - East Anglia THREE Offshore Windfarm

Please be advised that the crew transfer vessel NR Predator is expected to mobilise from the port of Lowestoft

Crew Transfer Vessel NR Predator will provide assistance during the construction phase of the East Anglia THREE Offshore Windfarm Array and will make regular transits between East Anglia THREE CDM and the ports of Lowestoft and Great Yarmouth.

Outer Thames Estuary Special Protection Area (SPA):

As required under Deemed Marine License Condition 13(1)(c)(v) to minimise disturbance to red throated diver in the Outer Thames Estuary Special Protection Area (SPA) during construction of East Anglia THREE, these areas shall as far as practicable be avoided during transits from 01st November to 31st March.

See detailed map on our bulletin website
Show More

Esvagt Cobra (OFCS ERRV) - East Anglia THREE Offshore Windfarm Array

Mariners are advised that Emergency Response and Rescue Vessel (ERRV) ‘ESVAGT COBRA’ is expected to mobilise from the port of Lowestoft circa the 03/11/2025.

The ERRV ‘ESVAGT COBRA’ provides standby emergency rescue services during the commissioning phase of the East Anglia THREE Offshore Converter station (OFCS) ‘EA3 OFCS’.

 ‘ESVAGT COBRA’ will carry out regular transits between East Anglia THREE Windfarm and the port of Lowestoft and is equipped with VHF multi-channel radios and mobile phones.

See detailed map on our bulletin website
Show More

Subsea Rock Installation - East Anglia THREE Export Cable Corridor

Mariners are advised that circa the 15/11/2025, Rock Installation vessel ‘Flintstone’ will transit to and commence SRI (Subsea Rock Installation Operations) within the East Anglia THREE Export Cable Corridor

NKT will conduct Subsea Rock Installation (SRI) operations along the East Anglia THREE export cable corridor using the vessel DPFPV Flintstone. Rock will be placed on the export cable at third party asset crossings and remedial locations. In/out surveys will be performed prior to and following rock placement.

All vessels are requested to maintain a 1.5 Nautical Mile safety distance from the Flintstone during operations and pass at a reduced speed.

Fishing gear and or other equipment with seabed intervention should not be deployed when approaching the working corridor.

During SRI operations, Flintstone will have restricted manoeuvrability as defined under COLREGs (International Regulations for Preventing Collisions at Sea, 1972). The vessel will display the appropriate day shapes and lights and will transmit an Automatic Identification System (AIS) message. To protect the cable in the working corridor, guard vessels have been deployed along the route (as detailed in East Anglia THREE Notice To Mariners 065-2025 ). The Guard Vessels will monitor and issue warnings to marine traffic operating within six nautical miles of the construction area, with a Closest Point Of Approach (CPA) of less than 1.5 Nautical Miles.

See detailed map on our bulletin website
Show More

Bos Prelude (OFCS Platform Supply Vessel) - East Anglia THREE

Please be advised that the platform supply vessel ‘BOS PRELUDE’ is expected to mobilise from the port of Emden circa the 02/11/2025. Earliest arrival at East Anglia THREE site circa the 04/11/2025.

The platform supply vessel ‘BOS PRELUDE’ provides supply service during the commissioning phase of the East Anglia THREE Offshore Converter station (OFCS) ‘EA3 OFCS’.

‘BOS PRELUDE’ will deliver supplies to the ‘EA3 OFCS’ and the jack-up vessel ‘JB 120’ (as long as installed next to the OFCS) as well as carry out regular voyages between East Anglia THREE Windfarm and the ports of Emden (Germany, main service port) and Lowestoft (UK) and is equipped with VHF multi-channel radios and mobile phones.

Outer Thames Estuary Special Protection Area (SPA):

As required under Deemed Marine License Condition 13(1)(c)(v) to minimise disturbance to red throated diver in the Outer Thames Estuary Special Protection Area (SPA) during construction of East Anglia THREE, these areas shall as far as practicable be avoided during transits from 01st November to 31st March.

See detailed map on our bulletin website
Show More

Cable Exposures - Rampion Wind Farm

Following the most recent subsea survey carried out in April 2025, updated information of inter-array cable exposures are listed and illustrated below. Analysis of survey data at the wind farm indicates the locations of exposures of sections of inter-array cables are subject to change resulting from dynamic movements of the seabed but are primarily focused within the South-South East of the wind farm area.

To Owners, Ships Agents, Masters, Pilots and Fishermen. Please see the following:

Risk of cable exposure within the Rampion Wind Farm

Following the most recent subsea survey carried out in April 2025, updated information of inter-array cable exposures are listed and illustrated below.

Analysis of survey data at the wind farm indicates the locations of exposures of sections of inter-array cables are subject to change resulting from dynamic movements of the seabed but are primarily focused within the South-South East of the wind farm area.

Mariners are reminded that further safety information related to array cable exposures can be found in “The Risks of Fishing Near Cables and Renewable Energy Structures”, published on the KIS-ORCA website https://kis-orca.org/safety/the-risks-of-fishing-near-cables-renewable-energy-structures/. General safety information can be found here: https://www.seafish.org/article/kingfisher-bulletins.. All mariners are requested to make themselves aware of their obligations for conducting activities over buried and protected cables under International and UK Cable (Subsea) Protection Legislation. Distribution:

As per Rampion Notices To Mariners Distribution List. Please feel free to share the information.

See detailed map on our bulletin website
Show More

Hywind Scotland Windfarm - Reported faults with navigational aids

Reported faults on AIS system, Fog Warning and Aviation lights at Hywind Scotland Windfarm.

Reported faults on AIS system, Fog Sounding Warning and Aviation lights.

Please review attached notice for further information on each item.

HS1 - Failed aviation lighting

HS1 & HS3 - No AIS Signal

HS2 & HS4 - Failed fog sounder

See detailed map on our bulletin website
Show More

Intertidal Pilot Drilling Activity - Irish Sea

Mariners are advised that the Mona Offshore Wind Project will be undertaking pilot drilling activities within the proposed Mona Landfall Survey Area within the Irish Sea. The drilling activity is anticipated to commence on the 27th October, and there is no associated vessel with these works.

The survey involves up to 3 pilot drills, which will be drilled from the land side of the proposed export cable corridor (above MHWS) and the drills will pass under the seabed in the intertidal zone. The pilot drills will be between 750-800m in length, of which up to 450m-500m will be under the marine environment, and ranging between 7m-12m below seabed level. The pilot drills will be drilled under the intertidal zone and nearshore area, and will not punch out to the seabed, with all works occurring wholly under the seabed.

See detailed map on our bulletin website
Show More

SubSea Soundscape Project - Celtic Sea

21 x scientific seabed passive acoustic monitoring systems will be deployed at positions across the UK Celtic Sea area. Each acoustic monitoring system will comprise: • Acoustic release system • Fish tag detection system (69 kHz) • Broadband hydrophone and cetacean click-train logger • Mooring frame with integrated components • Total vertical height: approx. 5 m above seabed • Minimum clearance above highest point: 55 m in shallowest locations Units will be subsurface with no surface markers.

Some primary aims of the SubSea Soundscape project are;

To support a new Marine mammal evidence base for the Celtic Sea.

To create a region wide acoustic soundscape model and open-source baseline acoustic data of the Celtic Sea integrating new S3 data and other secured acoustic data sources.

To Co-develop road maps for the use of acoustic soundscape models for consenting

Navigation Advice

  • Equipment is fully subsurface and presents no hazard to surface navigation.
  • Trawling, dredging, or seabed gear deployment in the vicinity of marked positions could be avoided to reduce risk of entanglement or equipment damage.
See detailed map on our bulletin website
Show More

Marine Mammal Monitoring-Passive Acoustic Monitoring Stations - East Anglia THREE Offshore Windfarm

Please be advised that Seiche Limited have performed a service on the 17 Passive Acoustic Monitoring (PAM) Stations that have been deployed on the seabed, in and at locations around the East Anglia THREE Offshore Windfarm area.

Service of the 17 Passive Acoustic Monitoring (PAM) stations that have been deployed on the sea bed, in and at locations around the East Anglia THREE Offshore Windfarm Area.

There is an exclusion zone of 250m around each PAM station, all marine traffic is advised to abide by the 250m safety zone and navigate with caution at all times.

For further information regarding PAM station servicing, please see attached East Anglia Three Notice To Mariners 064 - 2025.

See detailed map on our bulletin website
Show More

Construction of Wind Farm - Triton Knoll

Activities related to the development of the Triton Knoll wind farm continue, as detailed below. For background information visit: http://www.tritonknoll.co.uk. NtM 009-2025 - Cable Protection System & Rock Bag Campaign The Normand Sentinel will be conducting a subsea survey using an ROV and stabilising the cable protection system by using rock bags. Mariners are requested to give a 500m clearance to the vessel and all fixed structure locations whilst she is working in this area.

Mariners are advised that the following vessels continue to be active at the Triton Knoll Offshore Wind Farm (TKOWF) as outlined within previously issued NtM's:

Vessel Name

Type

Call Sign

MMSI

IMO

Operating Port

Commence Date

Windcat 11 Crew Transfer Vessel 2BIS9 235066459 N/A Grimsby 14/12/2020
Esvagt Havelok Service Operations Vessel OYFR2 219026496 9878981 Grimsby 25/09/2021
Njord Amundsen Support Vessel ZDSO3 236112802 1036355 Grimsby 10/05/2024
Normand Sentinel Support Vessel LASC7 257883000 9707716 Grimsby 29/10/2025

All vessels can be contacted via VHF channel 16 when operational in field.

*** Note ***

All 90 WTG's have now been fully installed, whilst WTG commissioning and service continues.

All Export Cables are fully installed/buried and need to be deemed live/energised.

All Inter Array Cables are fully installed and buried and need to be deemed live/energised.

Whilst the main installation works have been completed, major construction commissioning works are continuing.

*** Note ***

Whilst TKOWFL is reopening the site to fishing from the 14th December 2021, TKOWFL kindly request that all fishermen intending to fish within the boundaries of the Triton Knoll wind farm, contact the Triton Knoll control room prior to entering and exiting the field, and inform them of their fishing intentions

This precaution is requested to safeguard all vessels operational at the TKOWF site (including fishing vessels) and your cooperation, to ensure the safety of all parties is appreciated. The following contact details should be used when notifying the Triton Knoll control room of fishing activity:

Control Room Manager: Lee Wheat

Radio: VHF channel 16

Callsign: TK MCC

Phone: +44 1793 896250

Email: tkcr@rwe.com

*** Note ***

Application of Triton Knoll Wind Farm Safety Zones During Construction

The Secretary of State has granted the Application of Safety Zones on the Triton Knoll Wind Farm Project as follows:

  • 500m “rolling” safety zones around any structure where construction is being undertaken (as indicated by the presence of construction vessels).
  • 50m pre-commissioning safety zones surrounding partial structures or completed structures prior to commissioning.

Mariners are advised that all foundations monopiles have been installed and all inter-array and export cables have been installed.

Navigation Warning - 08th January 2021

Mariners are advised that the remnants of a Wave Rider Buoy sinker weight and partial rigging are located within the Triton Knoll Offshore Wind Farm Construction site at the following location;

53° 30.442N 000° 50.564E

It is advised that the partial rigging could potentially be floating up to 9.7m above the seabed, reducing the navigable safe water in the immediate area to 10m LAT.  Mariners are advised to avoid the indicated position by 250 metres.

Possible Dangers to Navigation - Properties of the polypropylene show that the rope is buoyant, this makes the line sensitive for thruster currents. Taking the site water depth into consideration (19.7m LAT) and the maximum expected height above seabed of the rope 9.7m the line is expected to be floating submerged at approximately -10m LAT. In addition, it is noted that over time sediments will be trapped between the fibres and the heavier rope may finally sink. The polypropylene rope may impose a risk to foul propellers / propulsion of vessels due to the buoyant nature of the rope. As the rope is submerged at a depth of ~-10m LAT the risk is considered minimum for vessels with a shallow draught (<5m) and medium for a vessel with a deeper draught (>5m). Over time sediments will be trapped between the fibres and the heavier rope may finally sink thereby reducing the risk to propellers/propulsion of vessels. The clump weight itself (chain) is expected to have sunk into the seabed and has no significant height above seabed. In addition, the edges of the clump weight are mostly rounded (chain), the risk the clump weigh imposes to fishing activities/gear is therefore considered to be minimal.

Navigation Warning - 16th March 2021

Mariners are advised that two UXO targets have been confirmed within the Triton Knoll Offshore Wind Farm Array.

Mariners are advised that the two confirmed targets are located within 20 metres water depth (LAT) and a 10 metre radius exclusion zone is required around each target.  The following table provides the coordinates and a description for each target.

Description of Target Latitude Longitude

Water Depth

(LAT) Metres

Required Exclusion

Zone (Metres Radius)

Archaeological - The item is thought to be an air-delivered bomb.  It appears to be in a stable condition and is resting on the seabed.  Marine growth and concretion cover the body, indicating it has been in situ for a significant duration. The tail section of the bomb is missing, which is typical of unexploded bombs from WWII found in these circumstances and there is a significant hole in the case. The dimensions and characteristics gathered are consistent with a 500kg German bomb. Considering the state of the bomb the Net Explosive Quantity of the bomb is likely to be <5kg. 53°31'50.249"N 00°47'45.908"E 20 10
Archaeological - The item is thought to be an air-delivered bomb.  It appears to be in a stable condition and is resting on the seabed.  Marine growth and concretion cover the body, indicating it has been in situ for a significant duration. The tail section of the bomb is missing, which is typical of unexploded bombs from WWII found in these circumstances and there is a significant hole in the case. The dimensions and characteristics gathered are consistent with a 500kg German bomb. Considering the state of the bomb the Net Explosive Quantity of the bomb is likely to be <5kg. 53°31'49.895"N 00°47'45.115"E 20

10

See detailed map on our bulletin website
Show More

Recovery of an Object at Sea - Seabed Frame

Vessel conducting search & retrieval activities to find & remove the Seabed Frame. This will involve a search area around the last known location. We request marine users to remain 500m away from all assets.

Last known location of the seabed frame is the deployed location as per coordinates given in this notice. Please ensure fishing gear is at a safe distance to avoid entanglement. Acitivities will commence in November 2025. Vessel mobilisation port TBC.

This Notice will be updated as further details are available.

Note: this notice is a replacemnt for Notice ID5300 which was originally submitted 26th August 2025.

See detailed map on our bulletin website
Show More

Marine Growth Campaign - Muir Mhòr Offshore Wind Farm

2 x Measurement Systems to be deployed with associated buoyage, mooring & anchoring within Marine Growth Campaign Area. We request marine users to remain 500m away from all assets and expect a mooring excursion radius of ~200m.

Muir Mhòr Offshore Wind Farm Limited will deploy 2 x Measurement Systems to collect data located within a 1.5km x 2.5km area. Once deployed this Notice will be updated with as laid co-ordinates. The campaign is expected to last up to 2yrs.

The works will consist of the deployment of two seperate systems with buoys connected to a mooring line & chain anchored to the seabed with backup recovery line. Please ensure fishing gear is at a safe distance to avoid entanglement. Works will commence in October/November 2025 and the installation vessel will mobilise from Peterhead Port.

Note: this notice is a replacemnt for Notice ID5254 which was originally submitted 18th August 2025.

See detailed map on our bulletin website
Show More

Main Bearing Replacement Campaign - Galloper Wind Farm

Jack Up Vessel Wind Energy operations on site at Galloper Wind Farm replacing 5 x Main Bearings across both North and South fields

Main Bearing MAjor Component Exchanges on 5 x WTGs

See detailed map on our bulletin website
Show More

WTG Installation Campaign - Dogger Bank A Offshore Wind Farm

The Jack-up WTG Installation Vessel, Voltaire, will install wind turbine generators (WTG) within the Dogger Bank A construction area.

The works will commence on the 05th of July 2023, continuing until approximately Q2 2024.  The works will be continuous, 24 hours a day.  A chart of the DBA construction area boundary coordinates and a table of WTG location coordinates is provided below. A running list of the completed WTG installations and the next locations to be installed is presented in the Weekly Notice of Operations.

During operations, the Voltaire will be restricted in its ability to manoeuvre as defined under COLREGs (International Regulations for Preventing Collisions at Sea 1972) and will display the appropriate day shapes and lights. The vessel will also transmit an Automatic Identification System (AIS) message.

During operations, a Statutory Safety zone of 500m radius will be in place around the Voltaire during the installation of WTGs.  The safety zone will be monitored by a guard vessel. The primary response will be to warn passing traffic of the ongoing works and any active safety zones, and to alert any vessels where an infringement may occur or has occurred.

See detailed map on our bulletin website
Show More

Potential Hazard for mariners - Hywind Scotland Windfarm

Following recent emergency repair works a section of inter array cable is not fully buried below the level of the seabed (short sections are on the seabed), in the following area: 57° 29,088' N 1° 22,338' W > 57° 29,834' N 1° 22,305' W > 57° 29,834' N 1° 22,495' W All vessels are advised to exercise caution if transiting through this area and it is recommended that any contact with the seabed is avoided.

A de-energised array cable has detached from the mooring anchor and is floating on the water surface, in the following area:

57° 29,088' N 1° 22,338' W > 57° 29,834' N 1° 22,305' W > 58° 29,834' N 1° 22,495' W

All vessels are recommended to refrain from transiting through the windfarm whilst this hazard is in place.

VESSELS in attendance:

MCS Swath IMO: 9808962. MMSI 235117181. Call Sign: 2JMP4

GV Karelle - IMO:9128386. MMSI 234325000 Call Sign: MWXN5

Normand Sapphire - IMO:9372169. MMSI 257282000 Call Sign: LNXW

Update28.08.2025 Potential Hazard for mariners - Hywind Scotland Windfarm. Today (Thursday 28th August), one of the array cables has become detached at one end from the mooring anchor at Hywind Scotland, the cable is de-energised .

Update 29.08.2025 Commencing on 30th August 2025, subsea visual inspections are required to be carried out at Hywind Scotland Windfarm on all 5 x Wind turbines and related Subsea equipment.

During this project we ask that a 200m exclusion zone is maintained by  from all Hywind Scotland Wind turbines.

See detailed map on our bulletin website
Show More

Metocean and Floating LiDAR Buoy Deployment - Talisk Offshore Wind Project

Green Rebel, on behalf of Magnora Offshore Wind, has deployed a Floating LiDAR (FLS) System buoy and a Directional Wave Rider (DWR) buoy at the Talisk Offshore Wind site, approximately 30km north of the Isle of Lewis for a minimum period of 24 months. The deployment took place on 21 September 2024. Post deployment of the FLS and DWR, service activities be carried out onsite at approximately six-monthly intervals. Additional notice will be provided prior to service activities being undertaken.

Show More

Cable installation - Q&E South - Newhaven, UK to Cayeux-sur-Mer, France

Global Marine have conducted the installation of the telecommunications cable from Newhaven UK to the French Territorial Waters boundary. All vessels associated with the project have left site.

The section from the French TW to the landing at Cayeux-sur-Mer will be installed at a later date, yet to be confirmed.

For a further breakdown of operations, please don't hesitate to get in touch.

See detailed map on our bulletin website
Show More

Crew Transfer Vessel NR Hunter - East Anglia Three Offshore Windfarm Array

Please be advised that the crew transfer vessel ‘NR Hunter’ is expected to mobilise in the port of Lowestoft Circa 15/08/2025

Crew Transfer Vessel NR Hunter will provide assistance during the construction phase of the East Anglia THREE Offshore Windfarm Array and will make regular transits between East Anglia THREE CDM and the ports of Lowestoft and Great Yarmouth. Outer Thames Estuary Special Protection Area (SPA): As required under Deemed Marine License Condition 13(1)(c)(v) to minimise disturbance to red throated diver in the Outer Thames Estuary Special Protection Area (SPA) during construction of East Anglia THREE, these areas shall as far as practicable be avoided during transits from 01st November to 31st March.

It is currently anticipated that weather permitting, operations will be carried out on a continuous basis (i.e. 24-hour working, seven days a week) ‘NR Hunter’ will remain on the project until construction is complete

See detailed map on our bulletin website
Show More

Metocean Equipment - Spiorad na Mara Floating LiDAR Service

The Spiorad na Mara Floating LiDAR has been serviced and returned to its original position

The Spiorad na Mara Floating LiDAR (FLiDAR) was successfully serviced and returned to its original position.

Positions of the FLiDAR is illustrated in Figure 1 and coordinates listed in Table 1 of the attached notice.

The remaining FLiDAR is scheduled for removal in March 2026, inclusive of any delays due to adverse weather conditions. An accurate removal date, along with vessel details for the operation, will be provided in due course.

See detailed map on our bulletin website
Show More

Caledonia Offshore Wind Farm - Clump Weight

During the recovery of a Seawatch Wind LiDAR Buoy (COWF-SWLB075) within the Caledonia Offshore Wind Farm, the mooring system’s clump weight detached and remains on site. Marine users towing demersal gear are advised to maintain a safe clearance distance (500m) from this location.

Clump weight is 2500kg, approximately 0.75m^3 and lies <1m on the seabed.

See detailed map on our bulletin website
Show More

Construction energy island - Princess Elisabeth Island in the Belgian part of the North Sea

Construction of the Princess Elisabeth Island. The exclusion zone around the construction site is marked by 4 cardinal buoys (ELI-N, ELI-E, ELI-S and ELI-W).

Transmission system operator Elia is building the Princess Elisabeth Island in the Belgian part of the North Sea. This artificial energy island is an extension of the electricity grid in the North Sea. It connects the future wind farms of the Princess Elisabeth Zone with the Belgian coast and creates new connections with neighbouring countries.

The energy island is built centrally in the Princess Elisabeth wind zone, approximately 45 km from the Belgian coast. Construction of the island will take several years. To ensure safety during the works, the Belgian government defined an exclusion zone within which only work vessels are allowed. This zone is marked by 4 cardinal buoys (ELI-N, ELI-E, ELI-S and ELI-W).

Seabed preparatory works took place in spring and summer 2024. The installation of the caissons started in April 2025 and will proceed untill autumn 2026. During the winter months, no installation works will take place. The exclusion area remains in force at all times.

More information about the Princess Elisabeth Island is available on the Elia website: https://www.elia.be/en/infrastructure-and-projects/infrastructure-projects/princess-elisabeth-island.

See detailed map on our bulletin website
Show More

Dogger Bank A and DBB Boundary Buoy As-Installed Locations

This notice describes the current Dogger Bank A and B boundary demarcation buoys in the Southern North Sea

A total of 32 construction boundary demarcation buoys will remain in location until the windfarm construction activities have been completed and handed over to the Operations and Maintenance teams.

Once the permanent Aids to Navigation (AtoN) have been installed on the WTGs, Trinity House will approve the permanent AtoN and the boundary buoys will be removed.

If anyone finds a buoy that is off station or encounters a buoy location where it is not functioning or is missing, they should report this to the Dogger Bank Duty Marine Coordinator as soon as possible.

See detailed map on our bulletin website
Show More

MP/TP Bolting and Grouting - East Anglia THREE offshore windfarm

After each TP has been installed by the Jack-up Vessel (JUV), Seaway Ventus, Contractor shall perform the TP Completions Scope with the Norside Supporter (CSV), with a delayed start from Seaway Ventus. CSV shall operate on a single 12-hour shift for the duration of the project. ETA For works is Circa 25/04/2025.Bolting and Grouting operations will be conducted by the Norside Supporter within the East Anglia THREE offshore windfarm area.

Norside Supporter Will be Bolting and Grouting 95 monopiles and transition pieces at the WTG locations set out in section 2.2 of this document. It is currently anticipated that weather permitting, offshore works will be carried out on a continuous basis (i.e. 24-hour working, seven days a week)

See detailed map on our bulletin website
Show More

Maintenance And Redeployment Of Weather Monitoring Buoy - East Anglia Three Offshore Wind Farm

Please be advised that Partrac Ltd have completed maintenance on the Northern weather monitoring buoy, installed within the East Anglia Three Offshore Wind Farm Area.

Positions for both North & South weather buoys are identified in the attached Notice To Mariners 005 -2025. There will be periodic maintenance for both weather buoys during construction of EA3.

There is an exclusion zone of 100m around the weather buoys, mariners are  advised to abide by the 100m safety zone and navigate with caution at all times.

See detailed map on our bulletin website
Show More

Crew Transfer Vessel NR Rebellion - East Anglia Three Offshore Windfarm Array

Please be advised that the crew transfer vessel ‘NR Rebellion’ is expected to mobilise in the port of Lowestoft circa 01/04/2024

Crew Transfer Vessel NR Rebellion will provide assistance during the construction phase of the East Anglia Three Offshore Windfarm Array and will make regular transits between East Anglia Three CDM and the ports of Lowestoft and Great Yarmouth. Outer Thames Estuary Special Protection Area (SPA) As required under Deemed Marine License Condition 13(1)(c)(v) to minimise disturbance to red throated diver in the Outer Thames Estuary Special Protection Area (SPA), during construction of EA3. It is anticipated that vessels which are transiting to Lowestoft and Great Yarmouth ports, such as for crew transfer operations, will transit through and/or in proximity to the Outer Thames Estuary SPA. These areas shall be as far as practicable be avoided during transit from 01st November to 31st March

See detailed map on our bulletin website
Show More

Monopile And Transition Piece Installation Campaign - East Anglia Three Offshore Windfarm

Mariners are advised that the Jack Up Vessel Seaway Ventus will commence monopile and transition piece installation operations within the East Anglia THREE offshore windfarm area circa the 27/03/2025. Operations will be conducted by Seaway 7 and the main working area will be inside the CDM Zone of the wind farm array.

Seaway Ventus will install 95 monopiles and transition pieces at the WTG locations set out in attached East Anglia Three Notice To Mariners 012 /2025. During the monopile and transition piece installation campaign, all vessels are requested to keep a 500m safety distance from the Seaway Ventus. It is currently anticipated that weather permitting, offshore works will be carried out on a continuous basis (i.e. 24-hour working, seven days a week)

During operations, the ‘Seaway Ventus’ will have restricted manoeuvrability as defined under COLREGS (International Regulations for Preventing Collisions At Sea, 1972). They will display the appropriate day shapes and lights and will transmit an Automatic Identification System (AIS) message.

See detailed map on our bulletin website
Show More

Notification of Guard Vessel - East Anglia Three Offshore Windfarm

Mariners are hereby advised that circa the 01/03/2025 the guard vessel Tess will commence guard duty operations at the East Anglia Three Offshore Windfarm area set out in section 2 of the attached Notice to Mariners.

The guard vessel ‘Tess’ will monitor vessel traffic in and around the East Anglia Three Offshore Windfarm 24hours a day, 7 days a week. The vessel will broadcast regular navigational warnings and will contact any non-project vessels they believe could cause potential hazards, risk of collision, or cause an interruption to project vessels or assets. She will be monitoring VHF Channel 16 and VHF DSC Channel 70 continuously throughout the operaton.

See detailed map on our bulletin website
Show More

Commencement of Construction of East Anglia Three Offshore Windfarm

Please be advised from circa 1st November 2024 East Anglia Three Offshore Windfarm construction works will commence, subsea boulder and debris clearance operations will be the first construction activity as per the attached NTM document. Followed by Scour protection Installation circa 05th November 2024 as per NTM 050 in attachment.

East Anglia THREE will be a large offshore wind farm, located 69 km off the Norfolk coast. With a projected capacity of approximately 1400MW, the wind farm shall supply electricity to approximately one million UK homes. Onshore construction for the project started in July 2022.

By use of multiple specialized offshore vessels,1 Offshore Convertor station (OFCS) & 95 offshore wind turbine generators (WTGs) will be installed within the East Anglia Three site boundary along with the associated inter array and export cables. The generated power will be transmitted via an installed External Cable (EC) from the OFCS to a shore side substation located in Bramford.

See detailed map on our bulletin website
Show More

Disclaimer

TO DOWNLOAD THIS FILE, YOU MUST AGREE TO THE TERMS AND CONDITIONS "TERMS" NOTED AT THE FOOT OF THIS WEBSITE WHICH APPLY TO YOUR USE OF THIS WEBSITE AND TO USE OF THE FILE YOU HAVE CLICKED TO DOWNLOAD. IF YOU DO NOT AGREE TO THE TERMS, YOU WILL NOT BE ABLE TO DOWNLOAD THE FILE AND YOU SHOULD NOT USE THIS WEBSITE. TO CONFIRM YOUR ACCEPTANCE OF THE TERMS AND TO COMMENCE THE DOWNLOAD OF THE FILE, PLEASE CLICK THE "DOWNLOAD" CHECK BOX. IF YOU DO NOT AGREE TO THE TERMS, PLEASE CLICK THE "CANCEL" BUTTON. YOUR ATTENTION IS DRAWN TO CONDITION 3 NOTED BELOW WHICH FORMS PART OF THE TERMS IN RELATION TO OUR LIABILITY TO YOU.

Agree and download Cancel
